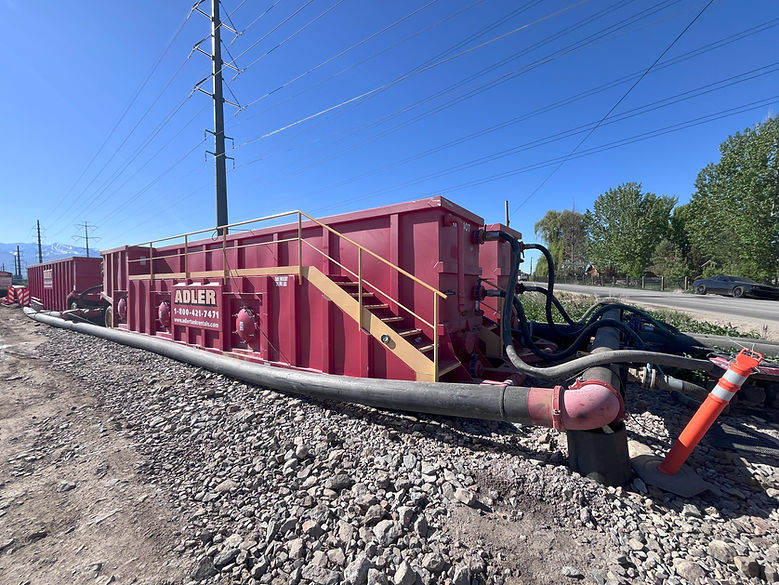

March 21, 2025 - Project Update

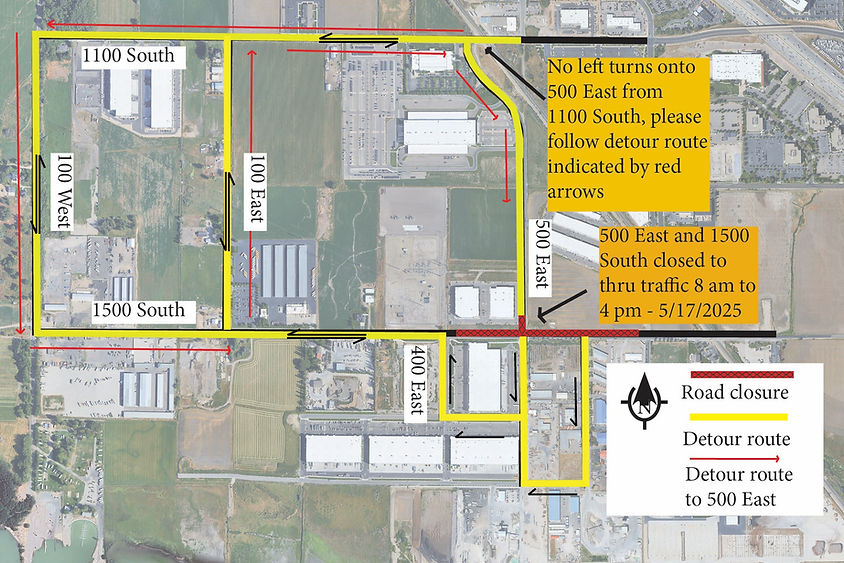

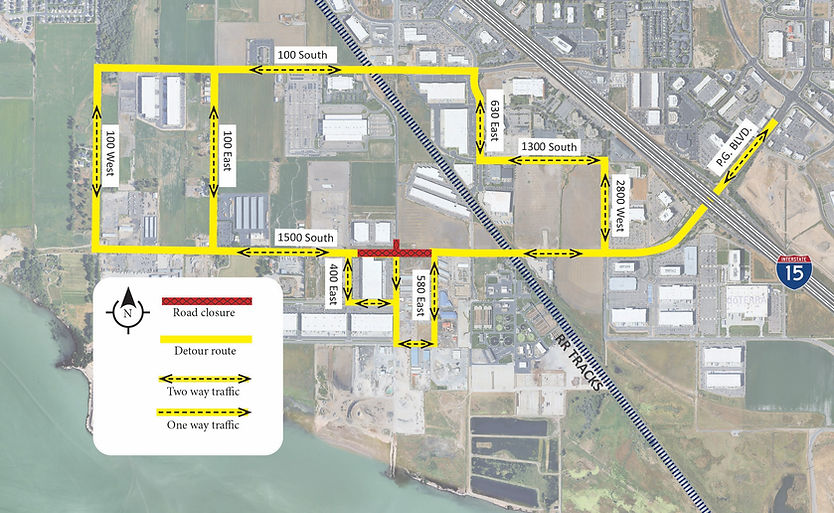

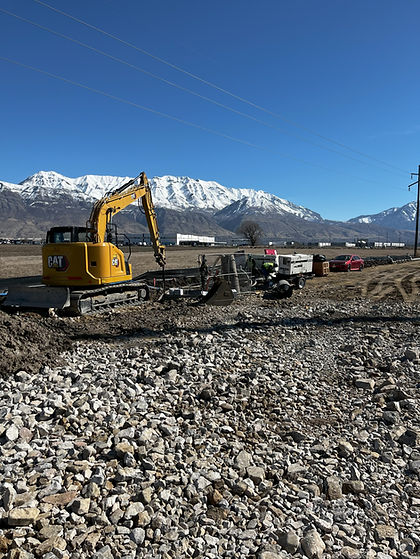

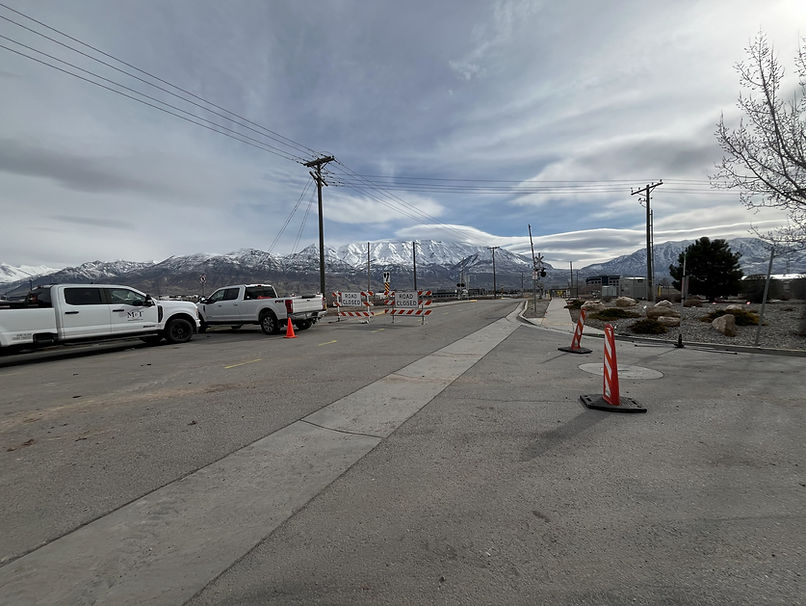

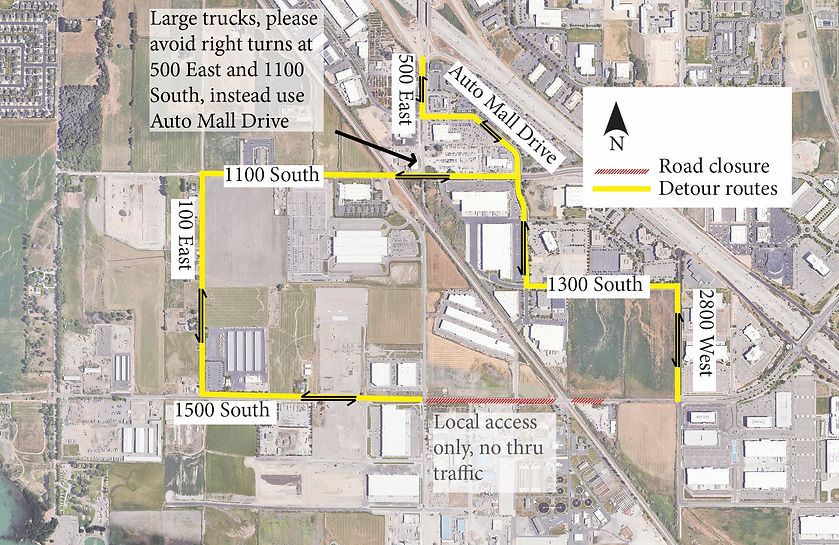

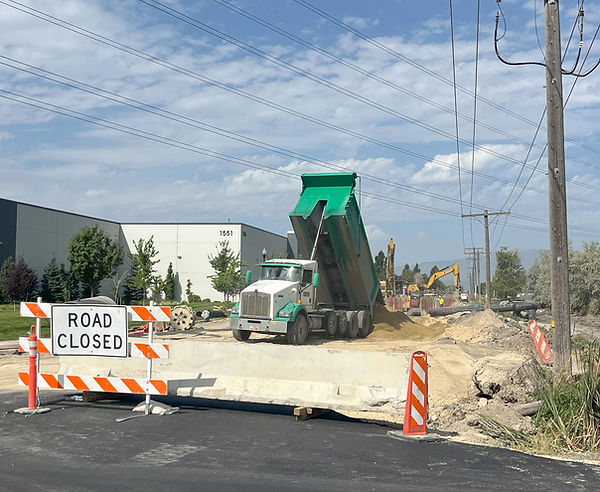

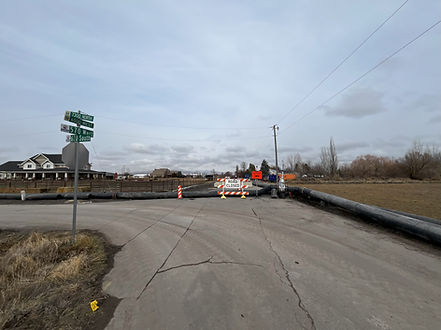

** Road Closure ** Monday, March 17th - thru Mid-June, 2025

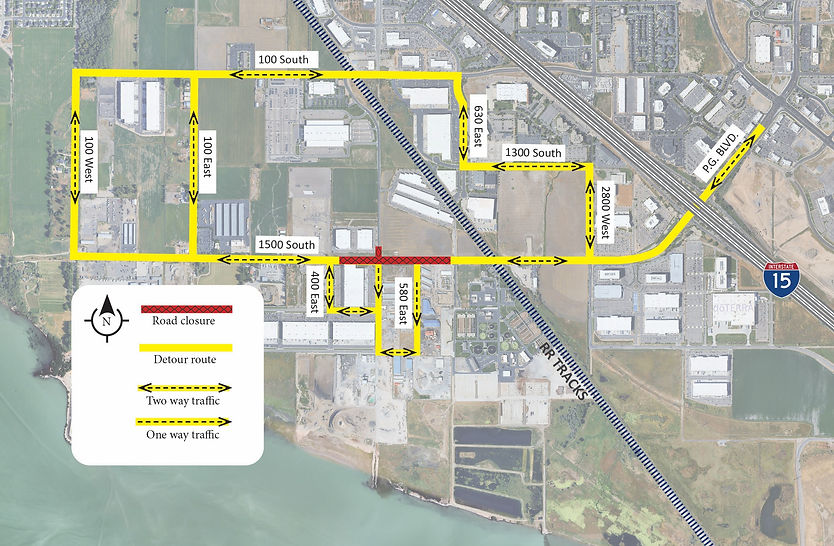

There will be a road closure on 1500 South between 500 East and the Union Pacific/UTA railroad tracks starting on Monday, March 17th and will last until mid-June. There will be no thru traffic between the railroad tracks and 500 East. There will be local access only along this same section of roadway to those businesses and properties. Access to this area will be from the west on 1500 South. See detour route below. A1600-foot section of pipe will be placed in the 1500 South road alignment. This section of pipe will be the deepest in the ground for the entire project, as it is gravity feed and adjacent to the treatment plant.
The purpose for the closure is to facilitate an open cut trench to place a new 54 inch sewer line into the Timpanogos Special Service District as a part of the main line upgrade coming from the communities in northern Utah County. We apologize for the inconvenience and appreciate your patience while this work takes place.
**Additional road closure in the area may cause congestion and delays**
While not related to this project, we have been informed that American Fork City will be doing their own road construction project further north of the TSSD project. Specifically, their project will take place near 620 South and Auto Mall Drive, east of 100 East. The work and temporary closure will not directly impact the TSSD project or closure, but traffic that would have used those streets will likely be detoured along 6800 North, which may cause some delays and congestion. Give yourself extra time if you need to travel through this area or avoid it all together if that is possible. This work is expected to last through the week of March 24th.

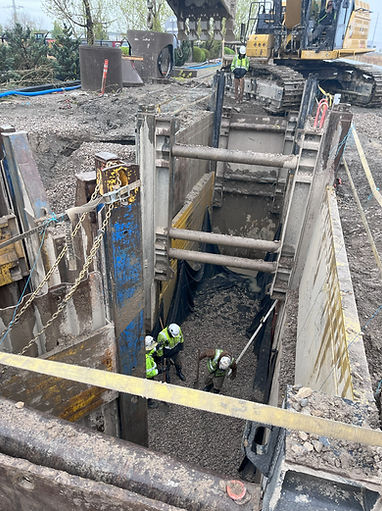

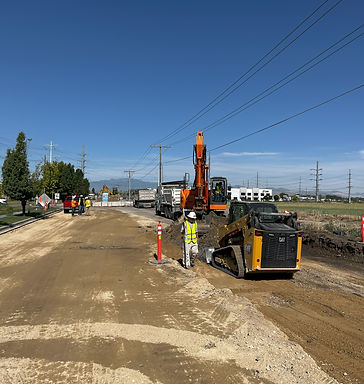

The contractor continues to make progress and is now primarily focused in two areas - trenching and laying pipe east of 100 East moving in a southeast direction and the plant upgrades at the Timpanogos Special Service District facility where the sewer is treated - this also includes the pipe trench in 1500 South.

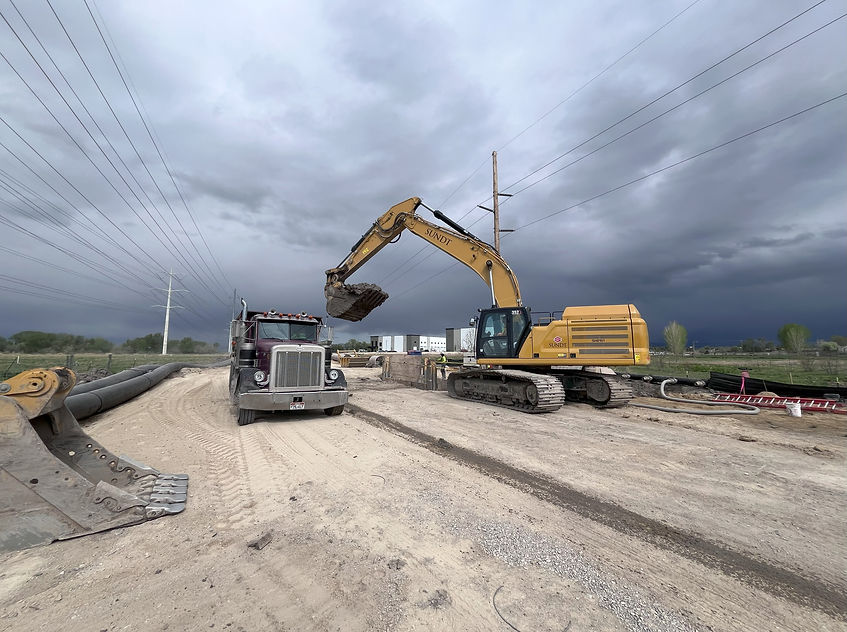

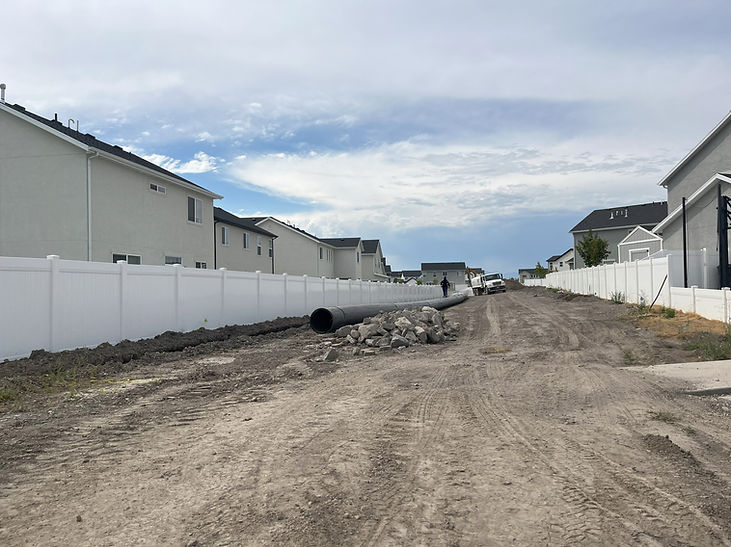

Since that last update the contractor has installed 200 feet of pipe in the ground and backfilled about 100 feet. All this is just north of the Alpine School Transportation facility.

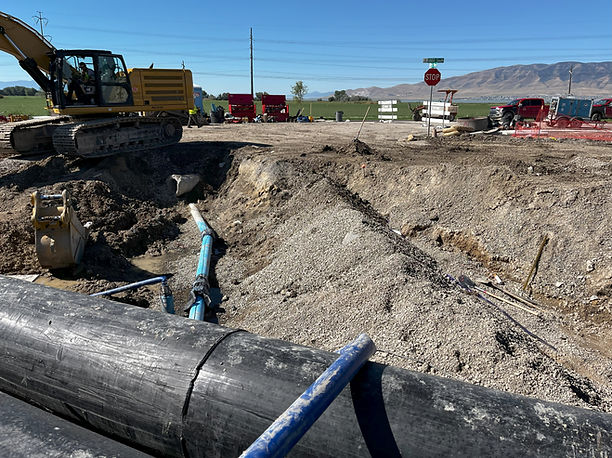

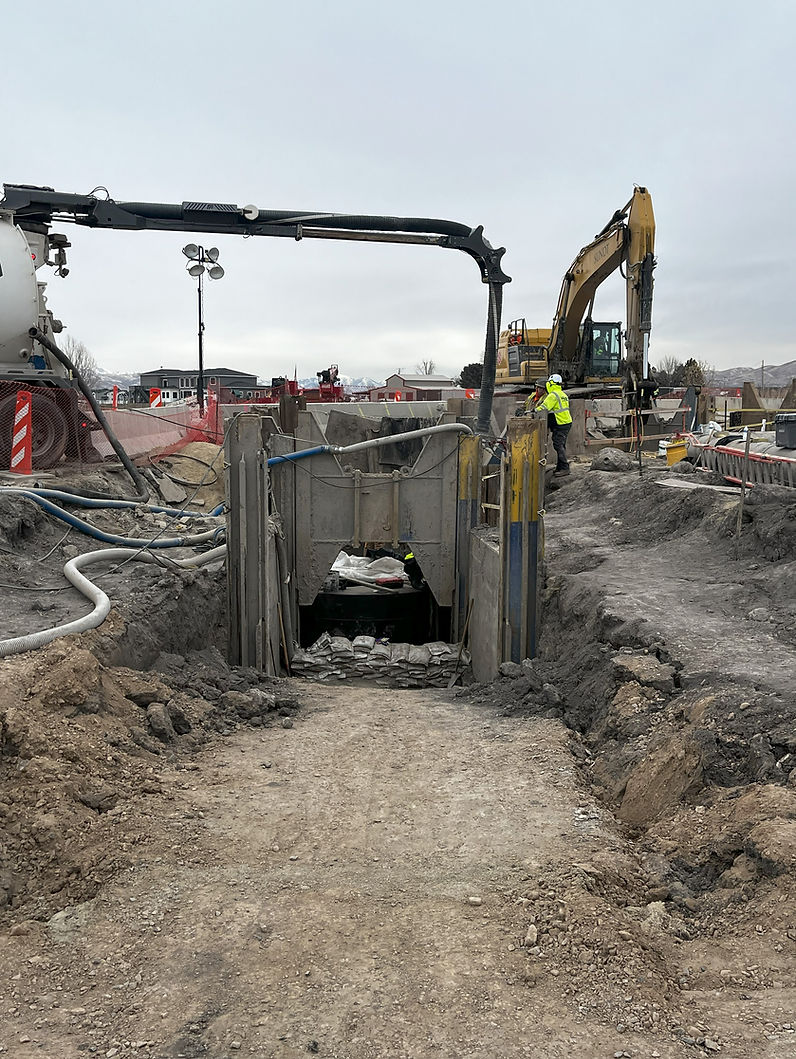

The pipe laying process in this area is basically the same, just different locations, but always includes pumps, bypass pipes, slide rail trench shoring and lots of heavy equipment and of course - the pipe.

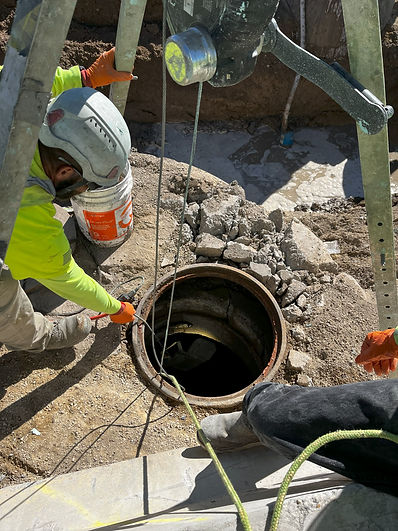

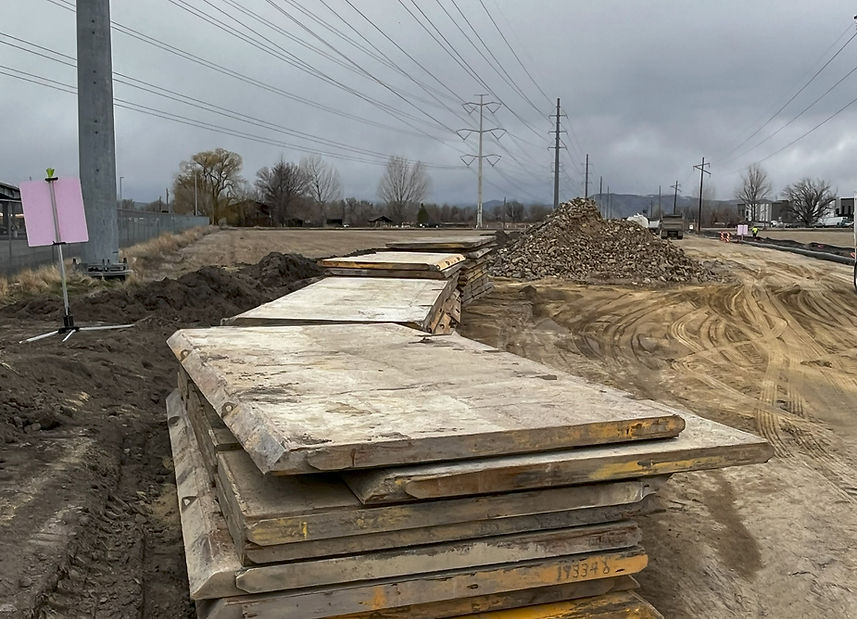

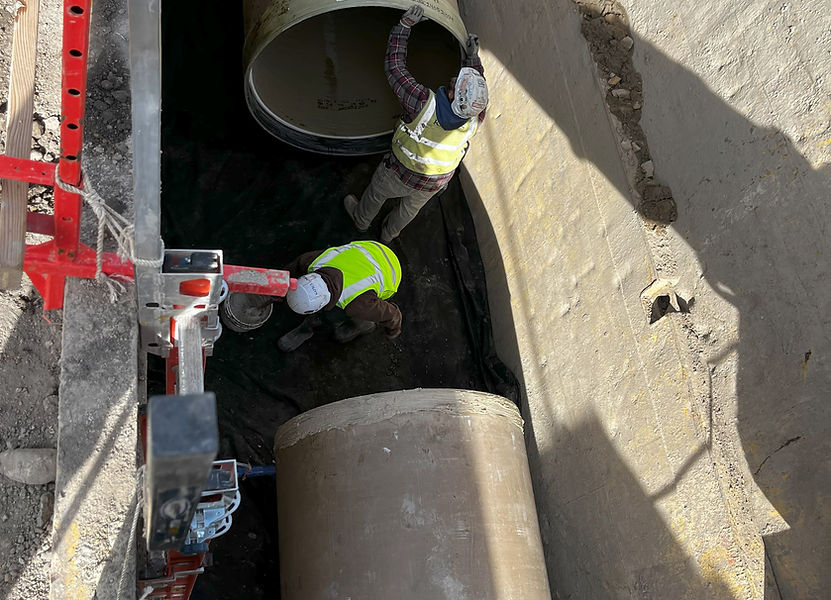

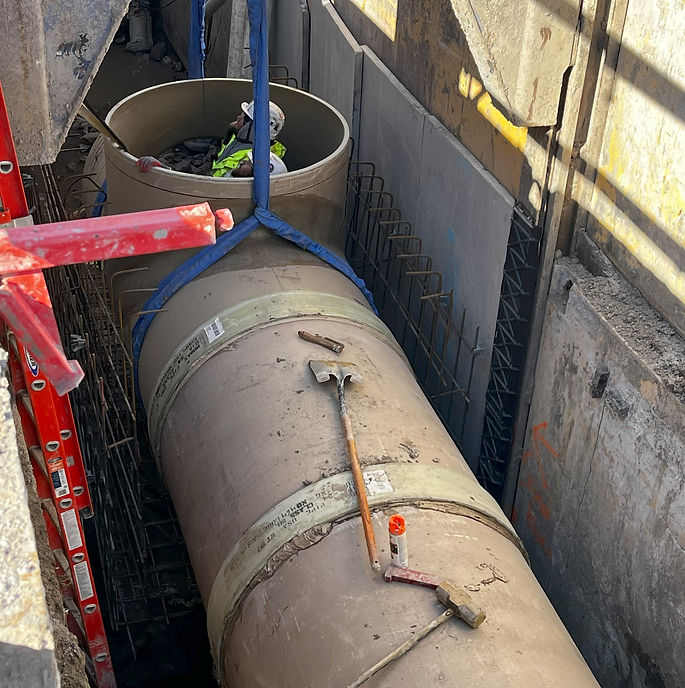

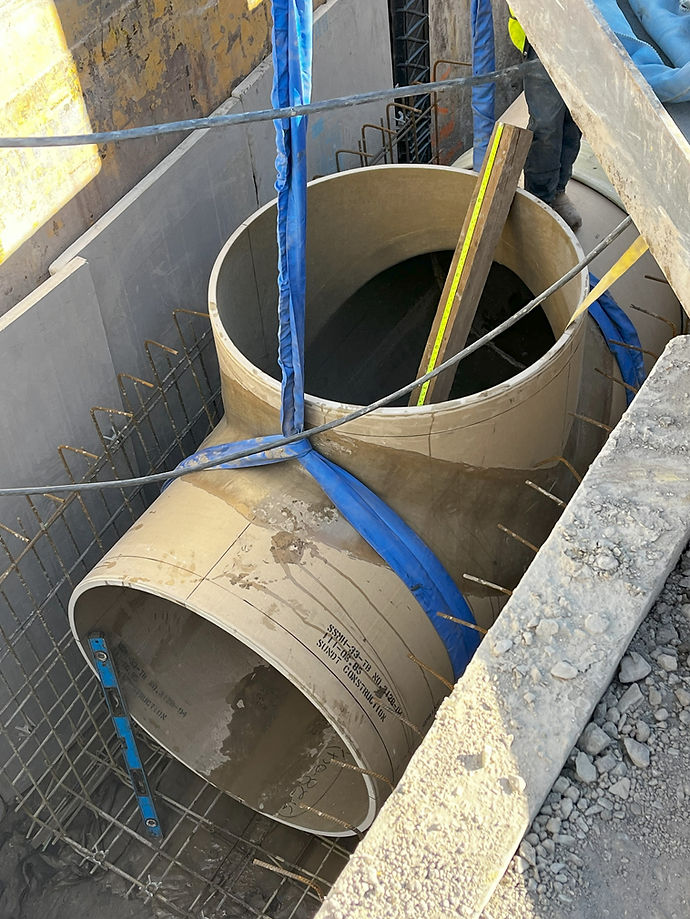

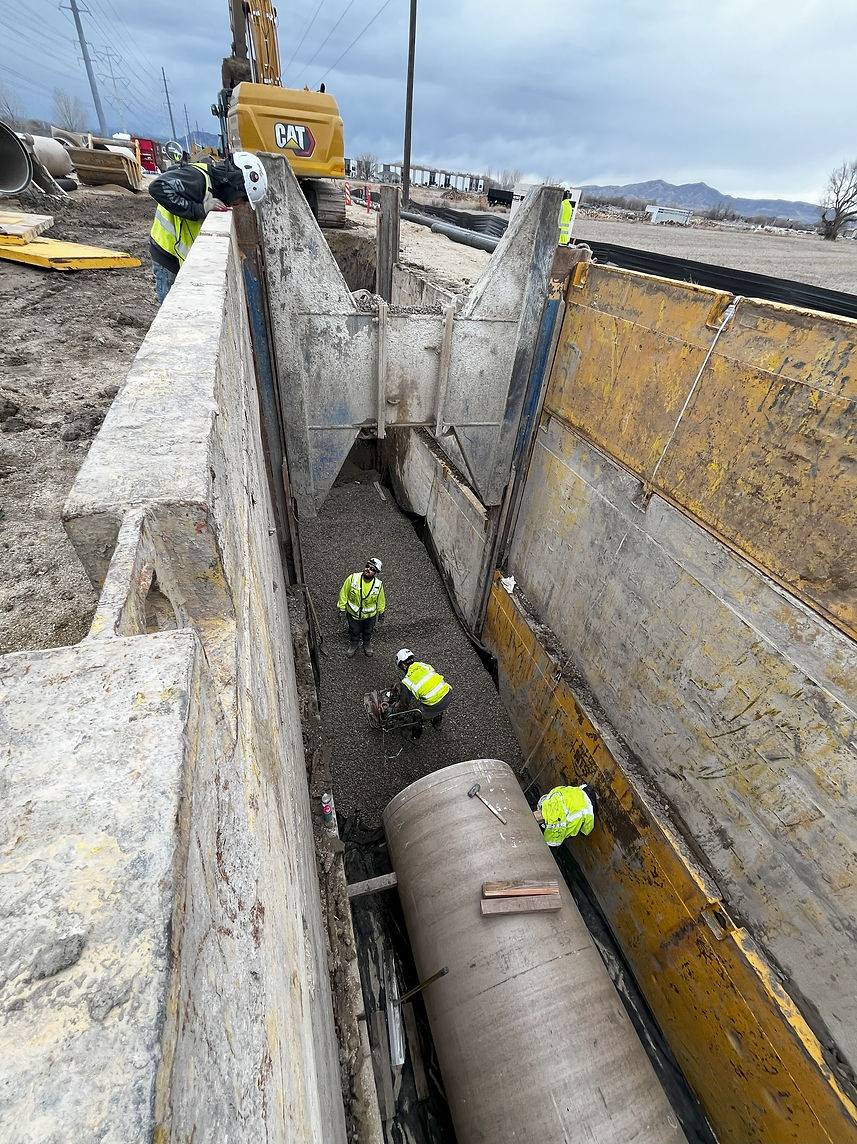

Two pre-cast concrete manhole boxes. These two are likely angle points where the pipe and the easement bend southeast and towards the treatment plant

An additional element of complexity is presented, and caution is required because of the proximity to the overhead power lines. As the excavator and lift operators are doing their jobs, they must always be aware of where the power lines are located in relation to the equipment arms and extensions.

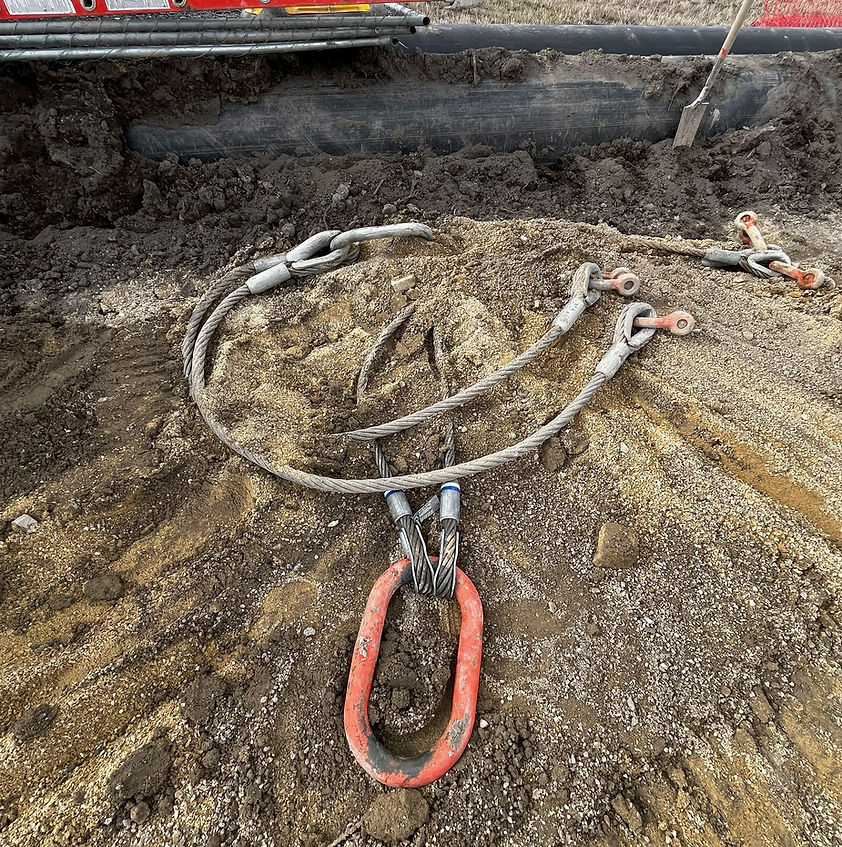

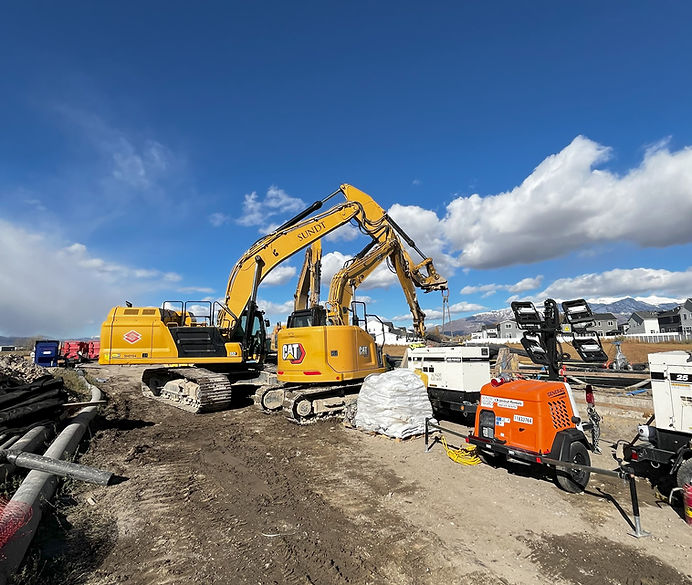

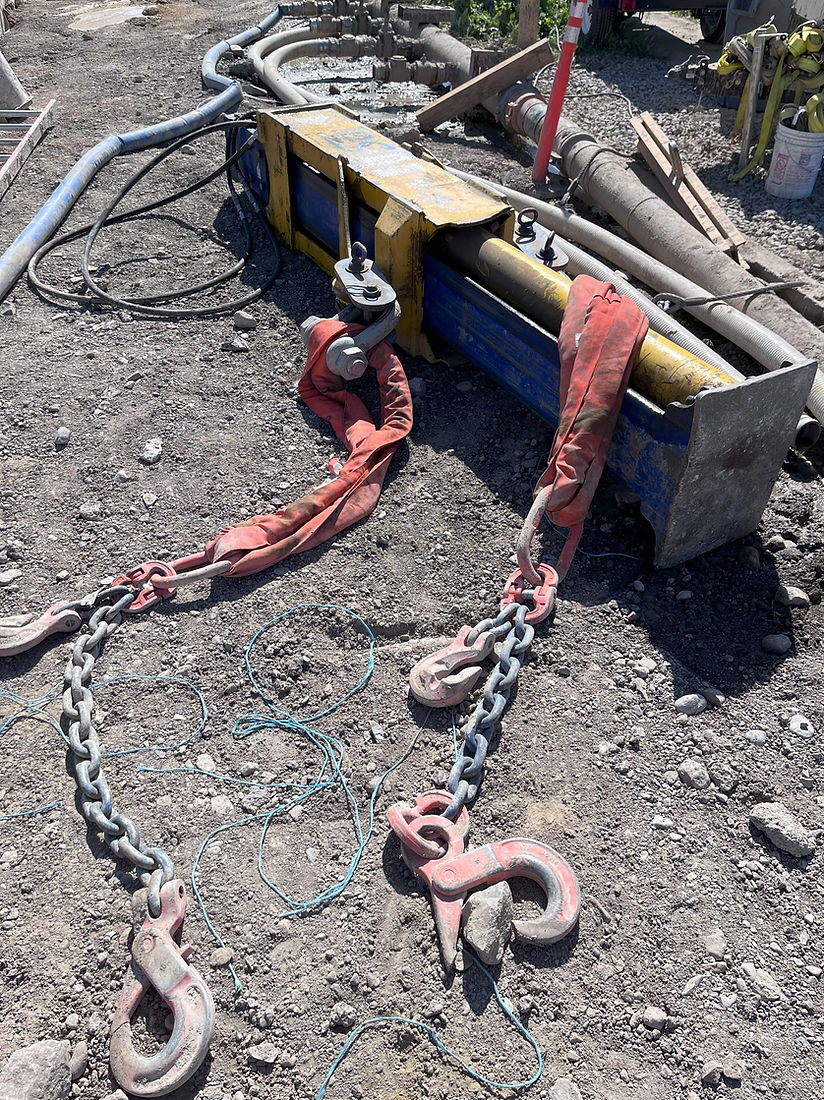

Riggings and hoist cables used to lift and move heavy piece of equipment and materials. For context, the large oval orange ring is over 18 inches long.

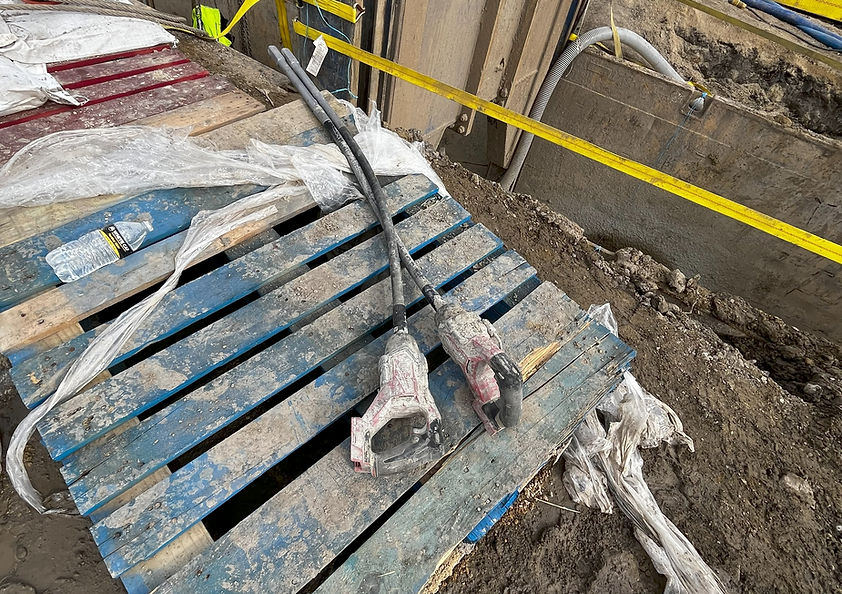

These two tools are called stingers and are used in the compaction process to make sure the concrete has no voids or large air pockets.

The other phase of the project is now in full swing with the road closure and detours. East of 500 East is for construction access and local traffic only. Please do not enter into this area unless you are a contractor and or headed to the Timpanogos Special Service District campus. All other businesses south of 1500 South should use 500 East to gain access. Several of the local businesses have informed their patrons, employees and material providers of the best alternative route - which is to use 500 East at 1500 South and head south.

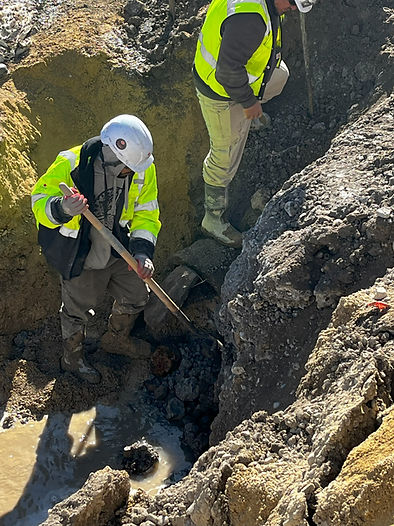

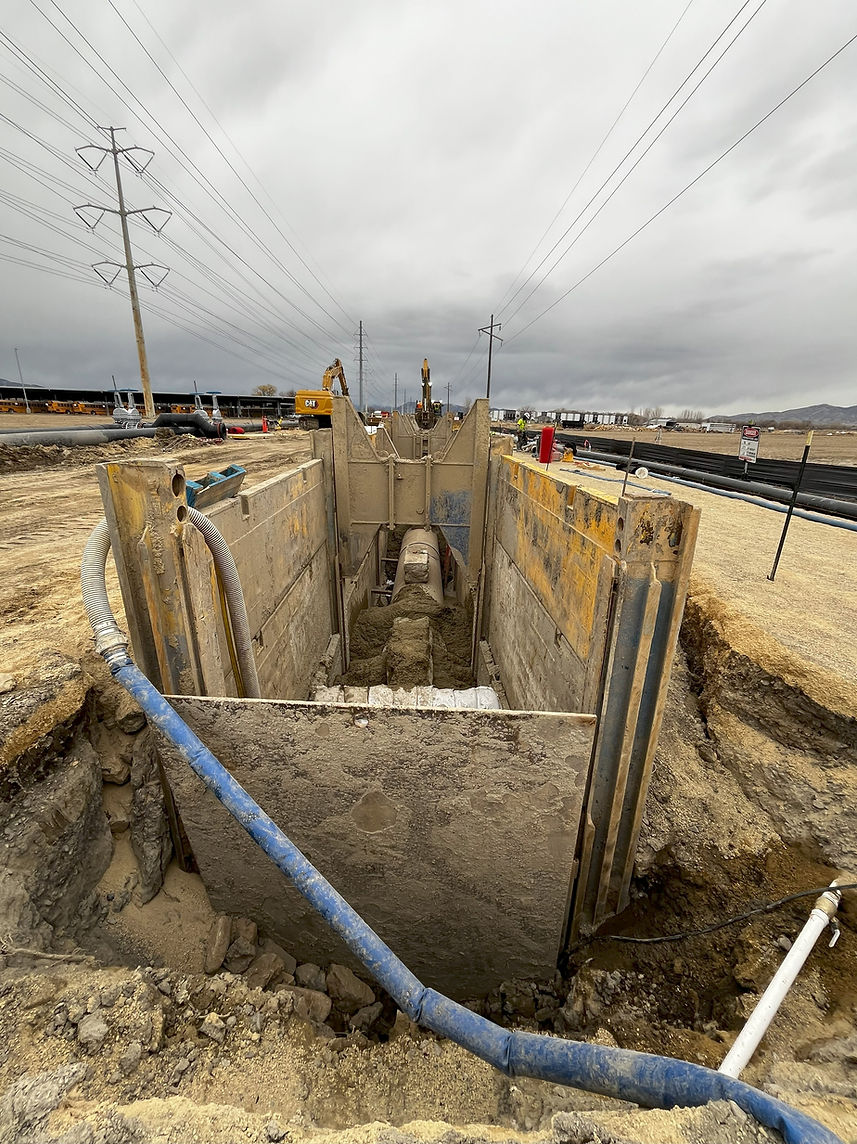

The pipe trench surface excavation zone has now been roto milled for ease of trenching as that work begins.

March 13, 2025 - Project Update
** Road Closure ** Monday, March 17th - thru Mid-June, 2025
There will be a road closure on 1500 South between 500 East and the Union Pacific/UTA railroad tracks starting on Monday, March 17th and will last until mid-June. There will be no thru traffic between the railroad tracks and 500 East. There will be local access only along this same section of roadway to those businesses and properties. Access to this area will be from the west on 1500 South. See detour route below. A1600-foot section of pipe will be placed in the 1500 South road alignment. This section of pipe will be the deepest in the ground for the entire project, as it is gravity feed and adjacent to the treatment plant.
The purpose for the closure is to facilitate an open cut trench to place a new 54 inch sewer line into the Timpanogos Special Service District as a part of the main line upgrade coming from the communities in northern Utah County. We apologize for the inconvenience and appreciate your patience while this work takes place.

The contractor continues to make progress and is now primarily focused in two areas - trenching and laying pipe east of 100 East moving in a southeast direction and plant upgrades at the Timpanogos Special Service District facility where the sewer is treated (pictures provided next week).
The pipe laying process in this area is basically the same, just different locations, but always includes pumps, bypass pipes, slide rail trench shoring and lots of heavy equipment and of course - the pipe.
Although this area is at least a mile from the previous location, the pipe is essentially the same depth, as it follows the slope of the ground to the treatment plant. As this is a gravity flow line, the ground is extremely flat with very little slope, the pipe placement in the trench is critical. If the pipe has any uphill slope in the wrong direction, it could cause challenges like back flow and surcharging that would impact the flow and ultimate arrival at the treatment plant.

March 10, 2025 - Project Update
** Road Closure ** Monday, March 17th - thru Mid-June, 2025
There will be a road closure on 1500 South between 500 East and the Union Pacific/UTA railroad tracks starting on Monday, March 17th and will last until mid-June. There will be no thru traffic between the railroad tracks and 500 East. There will be local access only along this same section of roadway to those businesses and properties. Access to this area will be from the west on 1500 South. See detour route below. A1600-foot section of pipe will be placed in the 1500 South road alignment. This section of pipe will be the deepest in the ground for the entire project, as it is gravity feed and adjacent to the treatment plant.
The purpose for the closure is to facilitate an open cut trench to place a new 54 inch sewer line into the Timpanogos Special Service District as a part of the main line upgrade coming from the communities in northern Utah County. We apologize for the inconvenience and appreciate your patience while this work takes place.

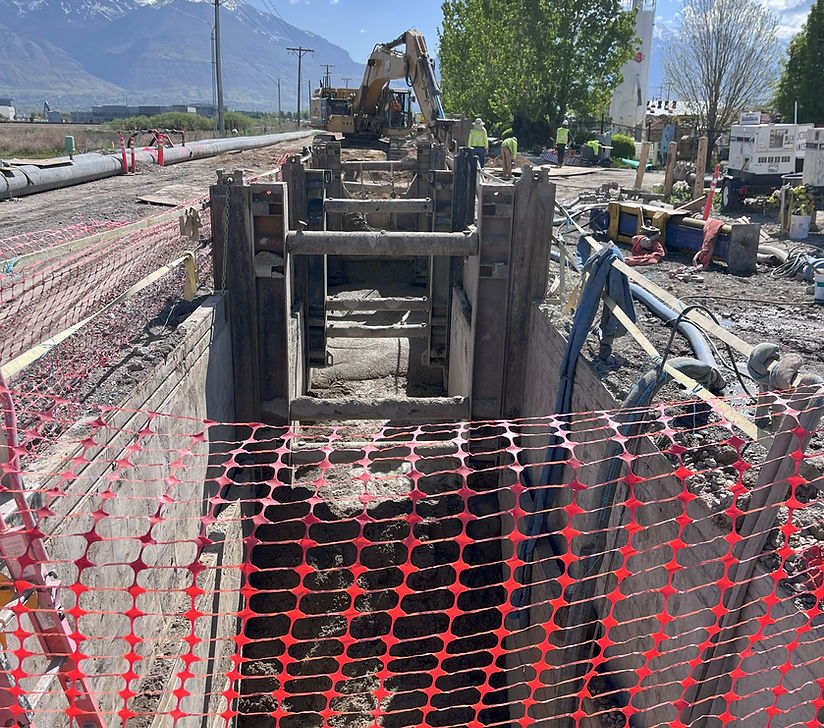

The contractor continues to make progress in three separate working areas. The 570 West intersection finally opened last week and traffic patterns there are now back to normal. There is still plenty of work to do in this area with cleaning up, restoring road surfaces, repairing driveways and roadside shoulders. It is still going to take more effort to get everything cleaned up and back to how it was before.

Here the contractor and the home builder are working together to re-establish the new grade around the new homes. Eventually this area will be re-landscaped as common area or yards belonging to homeowners.

The new area of trenching and pipe laying is just getting started north of the Alpine School District transportation facility. From here the contractor will work towards 500 East, and then further southeast on to the TSSD reclamation facility. This effort will include the 1500 South, 500 East and 100 East road closures. Thankfully, not all at the same time. Your continued patience is greatly appreciated.

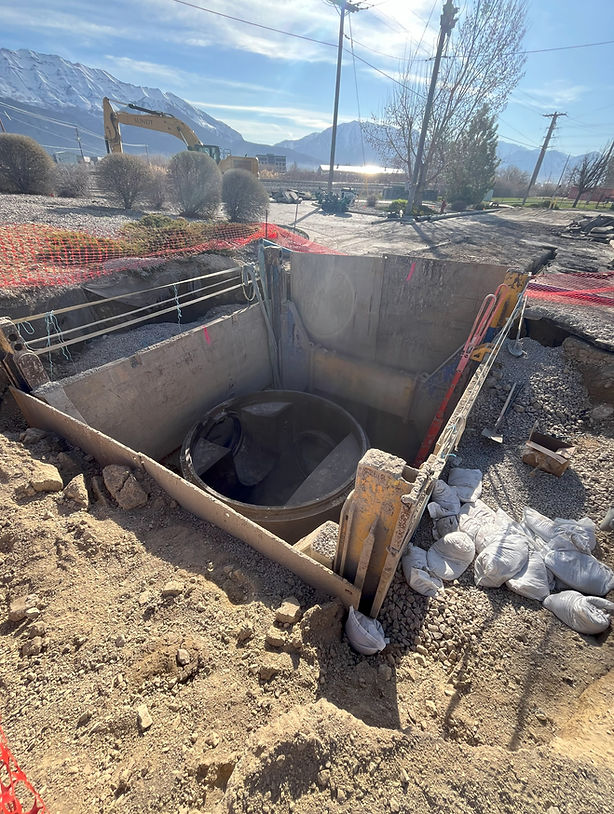

February 28, 2025 - Project Update
​
Grouting, epoxy, storm drains and dewatering
Since the last update the contractor has been focused on back filling the recently installed new sewer line and manholes. With a bit more back fill material, the trench wall protection plates will be removed, compaction complete and new surface paving will be applied to restore 570 West Street.

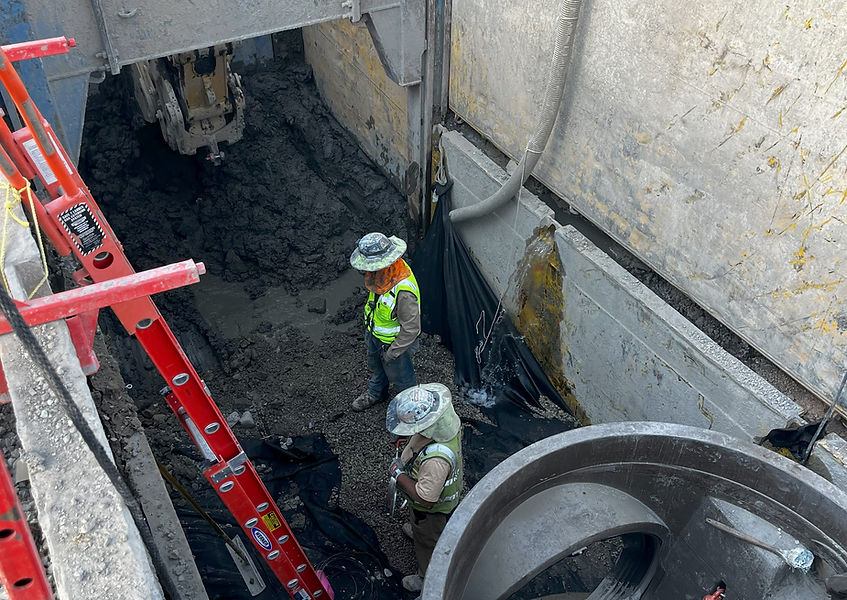

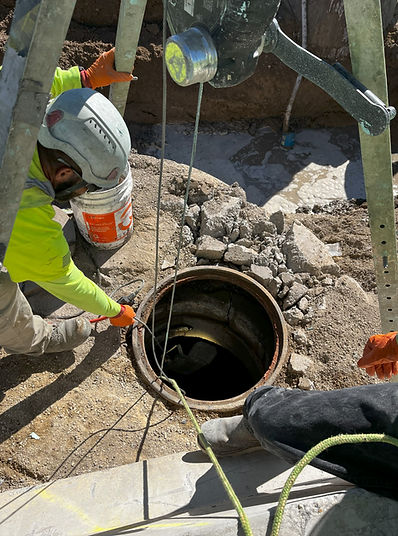

Here the contractor is re-establishing a storm drain pipe that was partially removed to make way for the new sewer line pipe below it.

The Timpanogos Special Service District has hired another contractor to perform maintenance and upkeep on an existing sewer manhole. This manhole has been by passed with the pumps, so there is no sewer flow in the manhole while the work is being performed. This separate contractor is using grout to fill in any holes or voids inside of this existing manhole. Once the grout dries, they will come back and apply a super strong, two-part epoxy to seal the entire inside of the manhole. Over the course of time sewer gases can erode and deteriorate the existing grout and allow for ground water infiltration. This maintenance work will provide a longer service life of the existing infrastructure.

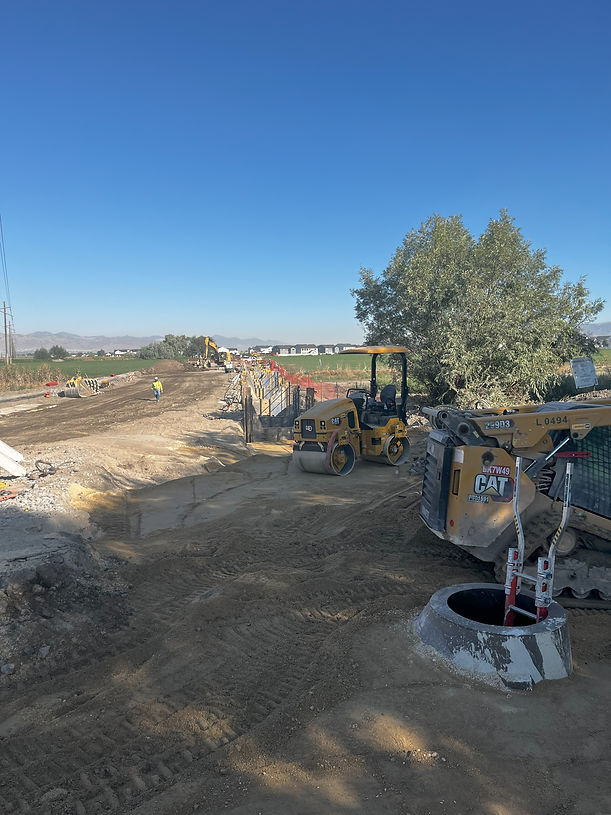

The contractor continues working on the east side of 100 East, just north of the Alpine School District Transportation Center. Here the contractor is establishing a dewatering well in preparation to start excavation and trenching to lay new sewer line pipe in the next few weeks. While 100 East will not be closed immediately due to this new area of work, there will come a point in the near future that 100 East will be closed off to thru traffic. Prior to this temporary road closure, impacted property owners will be given advance notice for detour options. Road closure and detour signs will also be posted to inform the driving public.

570 West will remain closed through this weekend but should be open the middle of next week. We apologize this has taken a little longer than anticipated. Please avoid this area until the road closed signs are removed.

February 20, 2025 - Project Update
Making connections and compaction to avoid uneven settlement
Since the last update the contractor has installed another 60 feet of Hobas 36-inch pipe. The work continues upstream but we are now to that point where they will connect into the existing 36-inch sewer line coming from the north in 570 West.

The end of the old pipe coming from the north in the 570 West alignment.

The new 36-inch pipe coming from the south in the 570 West alignment.

The gap to be closed between the new and existing pipe. This will be a complicated maneuver as this is rigid pipe and it does not bend. Another manhole will be used to make the connection with a healthy amount of grouting to fill any gaps and then it will be encased with CLSM - Controlled Low Strength Material.
Here the contractor is using heavy equipment - jumping jacks and vibratory plates - to ensure the back fill is properly compacted. The back fill is applied in layers or lifts about 6 to 8 inches each to make sure there are no voids which could cause undesirable settlement in the future.

Manhole number 36 is now being backfilled with a riser cone on top. This will allow for access into the pipe in the future, if needed.

A few tools of the trade - large pipe wrenches, three feet in length to tighten and secure pipe fitting.

570 West will remain closed through the end of February. Please avoid this area until the road closed signs are removed.

February 14, 2025 - Project Update
Quite possibly the heart of this project - Happy Valentines Day

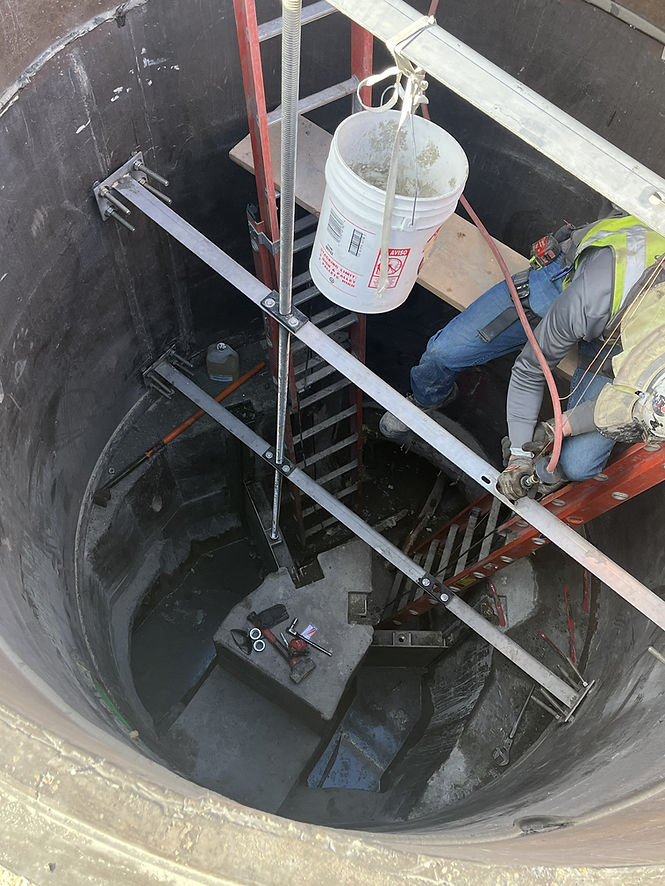

Since the last update the contractor has been working on and around manhole 36, the one reported from last week. This manhole was the largest and most complicated due to the two upstream entry points (at sharp angles) and one downstream pipe outflow. This very large resin composite manhole/junction box was placed and now is getting some detailed attention with grouting around the pipe entry and exit points. That is, the joints of the pipe connections of this size are often a bit oversized to accommodate for entry angle and any variation in direction and elevation - often times leaving small gaps that then need to be filled with concrete grout or mortar. This, and back filling around these joints insure there is no leakage in the future and no disconnections. While the sewer flow in the pipes are not pressurized, the flows can produce hydrologic pressure and movement within the manhole and pipe connection if not properly connected and secured.

Here a hydro vac truck is being used to removed any excess mud, water and unwanted fill before clean, secure structured filled is backfilled around the manhole.

Same job, two different parts. The track hoe is lowering a new pipe section into place, while the hydro vac truck is removing unwanted material - all in and around the same manhole

570 West will remain closed through the third week of February. Please avoid this area until the road closed signs are removed.

February 8, 2025 - Project Update
Really big structures and equipment

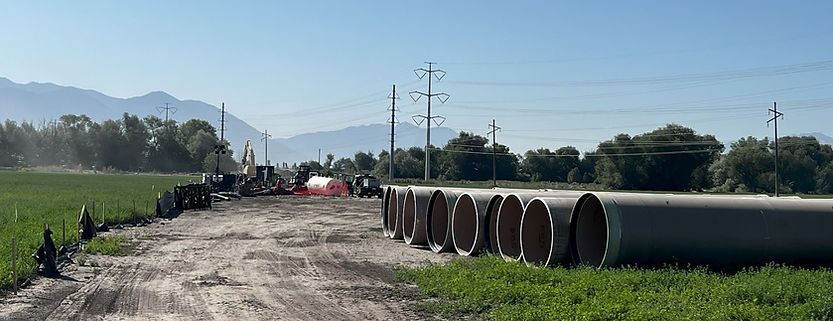

Since the last update the contractor has placed another 140 feet of large sewer main pipe in the ground and covered the same amount. A very large resin composite manhole/junction box will be placed over the next few days. The largest to be installed on the project, this 10 feet by 10 feet structure weighs 66,000 pounds - 33 tons - and will require a 300-ton crane to be set in place. The manhole itself comes in 4 different sections, stacked on top of each other. This manhole is the junction of a 36-inch and 48-inch upstream pipes with a 54-inch downstream pipe. The concrete box has to be this big and heavy to handle the capacity/volume of sewer flow and hydrologic pressure created from a change in the angle and direction of the flow. The crane is so big that portions of the road need to be reconstructed to handle the heavy equipment. The hole to accommodate the oversized manhole/junction box required additional excavation and shoring to make room for the structure and workers to set it in the precise location. All this is taking place in some of the most confined space along the sewer line easement and proximity to residential and agricultural structures.

The contractor has been splicing large sections of black plastic pipe that will provide for the by-pass of the existing sewer line while the new line is installed.

570 West will remain closed through the third week of February. Please avoid this area until the road closed signs are removed.

January 31, 2025 - Project Update
Progress continues
Since the last update the contractor has placed another 60 feet of large sewer main pipe in the ground and covered another 60 feet. The pipe laying operation is now at its most confined working area which presents several challenges. Here the contractor is taking special care as they work around an existing water line. Pipe flotation continues to be an issue as water in the trench and flowable fill is placed, often causing the pipe to float and get out of alignment. Additional weight and shoring are used to keep the pipe in place.

The contractor is now getting ready to splice large sections of black plastic pipe that will provide for the by-pass of the existing sewer line while the new line is installed.

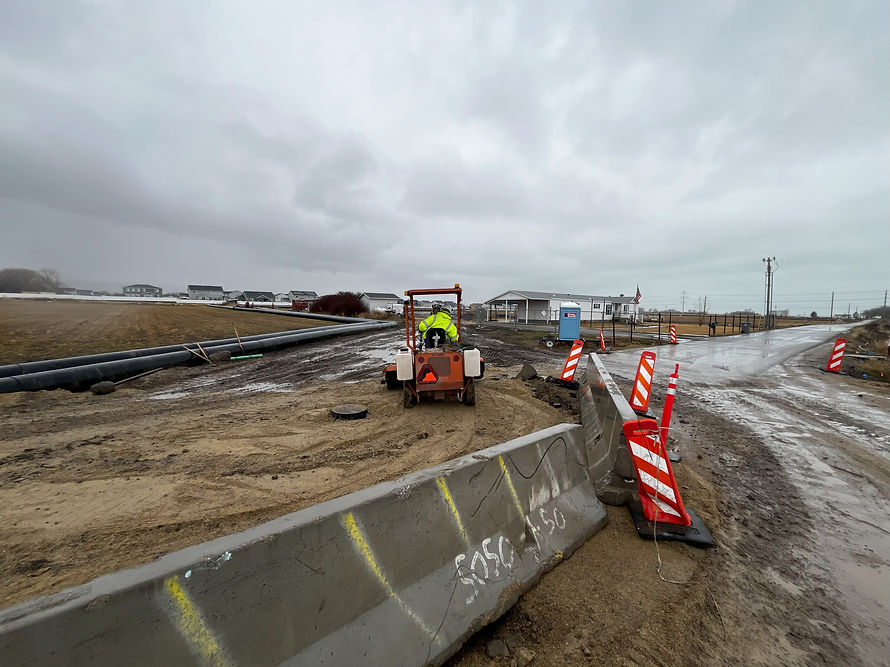

It is anticipated that 570 West will remain closed through the third week of February.

January 24, 2025 - Project Update

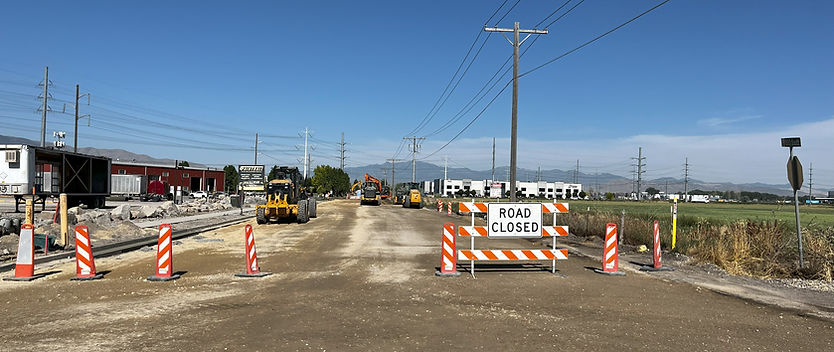

Three working areas
Since the last update the contractor has placed another 80 feet of large sewer main pipe in the ground and covered another 120 feet. The pipe laying operation is now at its most confined working area which presents several challenges. First, there is not a lot of working room based on the existing constraints of a narrow easement and existing structures - including a home. The contractor is taking great effort to not impact or damage adjacent property and structures. Second, because all this area is farmland and lake bottom, as the pipe is deep in the ground the water table is high, and the sidewall ground pressure is extreme. This requires a variety of approaches to maintain trench walls - slide rail and large steel plate shorting. Removing the shoring, with the increased pressure from water and mud can potentially damage the newly placed pipe, if great care is not taken.

The contractor is also now working in a new area, just north of the Alpine School District Transportation facility. This area is being cleared of vegetation and topsoil to expose the working surface before the trench excavation effort begins.

The third area of work is at the Timpanogos Special Service District facility itself - the waste treatment plant at 6400 North 5050 West, American Fork. Here the contractor is making preparations as a work yard, material storage and where significant improvements will also be made to facilitate the new 60-inch main sewer line.

January 9, 2025 - Project update - Asphalt is scheduled, and working in confined spaces.

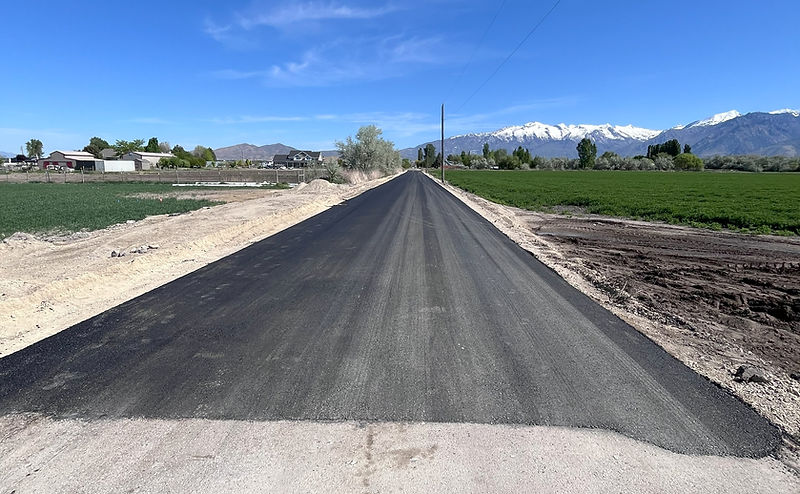

The contractor is scheduled to lay temporary asphalt next Tuesday, January 14th to replace the asphalt that was removed in order to accommodate the new 60-inch sewer pipe. This temporary asphalt will cover the compacted road base and provide an adequate surface during the winter months and through the end of the construction project. In August the contractor will come back and remove the temporary asphalt and apply a fresh layer. Note that the majority of curb, gutter, and sidewalk has been replaced - this is permanent. The paving operation will take place on 250 West, 360 West, 420 West and the cul-de-sac. Watch for traffic control panels, heavy equipment, and construction workers. Please slow down and be alert as some sections of roadway will be temporarily closed for the paving operations. We appreciate your continued patience as this part of the project wraps up.

Continued Progress with the pipe laying operation. Since last week another 140 feet of pipe was placed and covered. The next section of pipe to be placed will be a real challenge for the contractor as they approach 570 West and the Christensen home. The narrow width of the easement and the space between the existing home and outbuildings will require careful operation and planning.

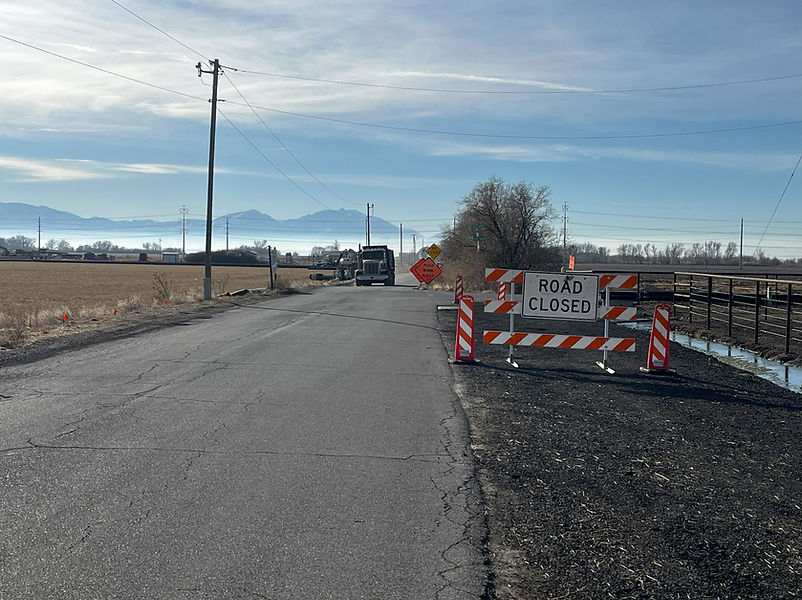

January 6, 2025 - Project update - Road closed, more restoration, and the pipe laying continues.

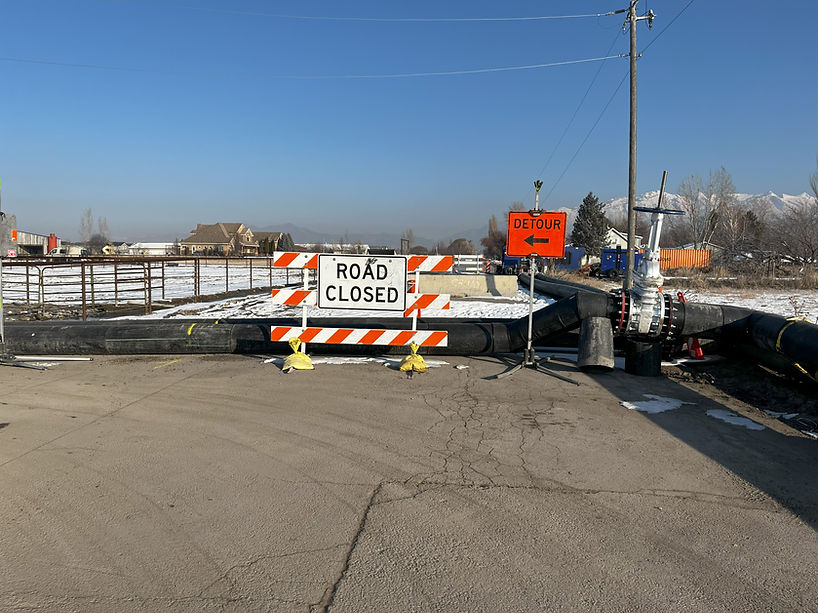

ROAD CLOSURES - 570 West (6500 West) is now closed and will remain closed through the middle of February. The purpose of the road closures is to allow the contractor to open cut the road and place a large 60-inch sewer main line under the roadway and to make the necessary connections to both upstream and downstream sewer main lines. The closure also accommodates the bypass lines, as there is no way to completely shut off a gravity flow sewer line, it must be diverted or "bypass" around an area and then back into the main line. The bypass allows the contractor to dig, place, and backfill the new pipe and allow the sewer flow to continue, but in an alternative pipe until the new pipe is ready to receive the existing and future sewer flow.
Watch for traffic control and detour signs.

Continued Progress & Restoration - The last two weeks the contractor placed almost 260 lineal feet of sewer pipe. All this took place in the farmland to the north and west of the Woodside Homes, Stonecreek neighborhood. Much of the visible work taking place in the residential area is restoration of curb, gutter, sidewalk and re-establishing the grade.

December 23, 2024 - Project update - Road closures in full swing, more restoration and the pipe laying continues.
ROAD CLOSURES - There will be two road closures, one immediately following the other. The purpose of the road closures is to allow the contractor to open cut the road and place a large 60-inch sewer main line under the roadway and to make the necessary connections to both upstream and downstream sewer main lines. The closures also accommodate the bypass lines. That is, there is no way to completely shut off a gravity flow sewer line, it must be diverted or "bypass" around an area and then back into the main line. The bypass allows the contractor to dig, place and backfill the new pipe and allow the sewer flow to continue, but in an alternative pipe until the new pipe is ready to receive the existing and future sewer flow.
The first closure will start Monday, December 16th, 7300 North (620 South) and will be closed at approximately 6611 West or about 650 feet West of 6500 West (570 West). This closure will last most of the week and will not permit east/west traffic through this area. Depending on which side of the closure you live on, you will want to access 7750 North (200 South) via 900 West, west of the closure, or 6500 West (570 West) east of the closure. Watch for traffic control and detour signs.
The second closure will start Monday, December 23rd on 6500 West (570 West) just north of 7300 North (620 South) will last two months. This closure will not permit direct north access onto 7750 North (200 South) via 6500 West (570 West). Access to 7750 North (200 South) will be via 7300 North (620 South) and 900 West. Watch for traffic control and detour signs.

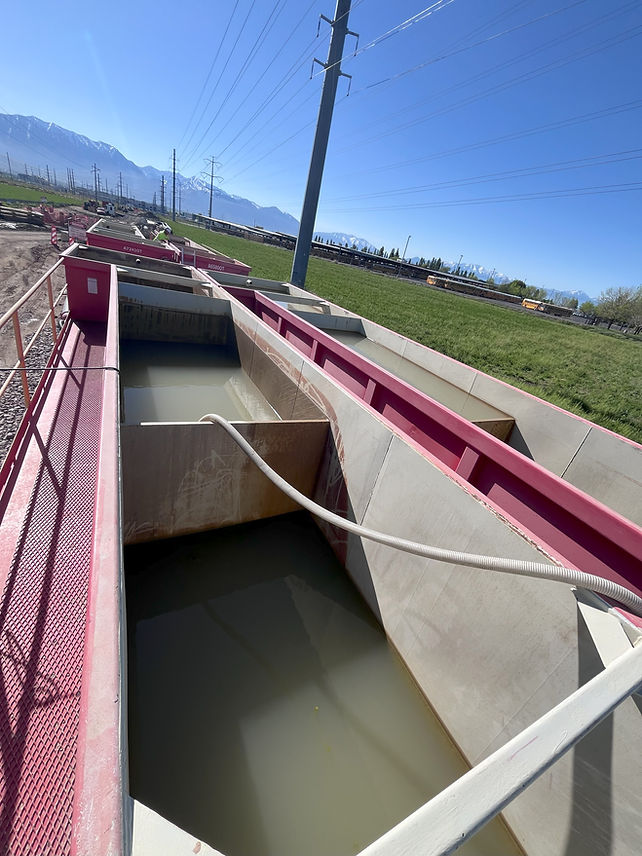

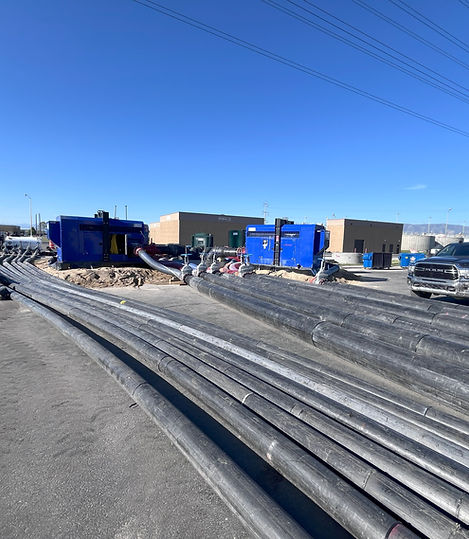

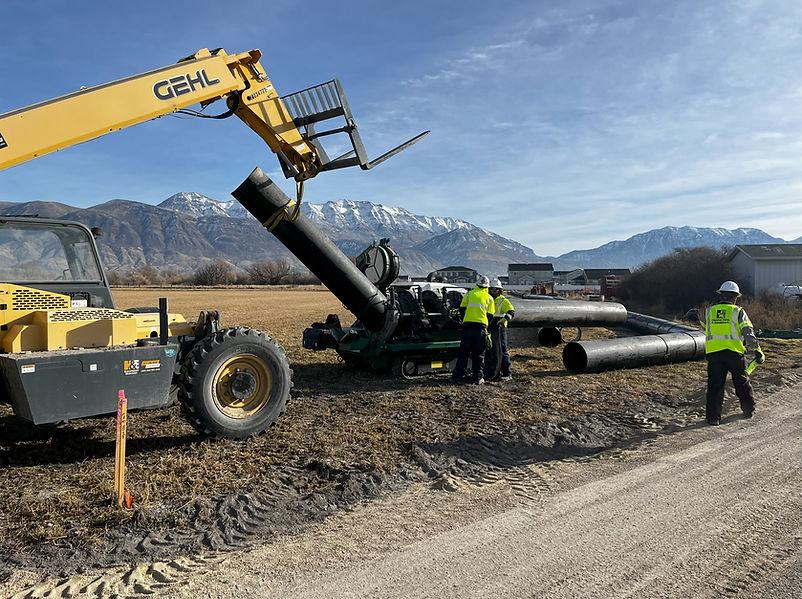

The two large, black plastic pipes are used to bypass the existing main sewer line while the new one is being constructed in the existing sewer easement held by the TSSD.

The piece equipment behind the operators is used to fuse the black pvc pipe together. The machine holds the two sections securely, a set of blades cuts the pipe and make each edge smooth. Another process heats the two pipe ends to 400 degrees and then the operator has 15 seconds to use the machine to bring the pipe ends together to form a joint that is stronger than the pipe itself. This pipe fusing machine can literally make a continuous section of pipe by keep adding another piece and it can also do angles for turns.

Continued Progress & Restoration - This last week the contractor placed almost 200 lineal feet of sewer pipe and covered 120 feet. All this took place in the farmland to the north and west of the Woodside Homes, Stonecreek neighborhood. Much of the visible work taking place in the residential area is restoration of curb, gutter, sidewalk and re-establishing the grade.

December 13, 2024 - Project update - Road closures, more restoration and the pipe laying continues.
ROAD CLOSURES - There will be two road closures, one immediately following the other. The purpose of the road closures is to allow the contractor to open cut the road and place a large 60-inch sewer main line under the roadway and to make the necessary connections to both upstream and downstream sewer main lines.
The first closure will start Monday, December 16th, 7300 North (620 South) and will be closed at approximately 6611 West or about 650 feet West of 6500 West (570 West). This closure will last most of the week and will not permit east/west traffic through this area. Depending on which side of the closure you live on, you will want to access 7750 North (200 South) via 900 West, west of the closure, or 6500 West (570 West) east of the closure. Watch for traffic control and detour signs.
The second closure will start Monday, December 23rd on 6500 West (570 West) just north of 7300 North (620 South) will last two months. This closure will not permit direct north access onto 7750 North (200 South) via 6500 West (570 West). Access to 7750 North (200 South) will be via 7300 North (620 South) and 900 West. Watch for traffic control and detour signs.

Continued Progress & Restoration - This last week the contractor placed almost 180 lineal feet of sewer pipe, covered 100 lineal feet of flowable fill and backed filled 40 feet of the pipe - up to surface grade. All this took place in the farmland to the north and west of the Woodside Homes, Stonecreek neighborhood. The bypass pipes and pumps have all been moved upstream and functioning well. Much of the visible work taking place in the residential area is restoration of curb, gutter, sidewalk and re-establishing the grade.

Getting ready for new curb, gutter and sidewalk.

New curbing around the cul-de-sac.

Re-establishing the grade.

The batch plant and materials storage yard is gone.
December 6, 2024 - Wrap up and restoration

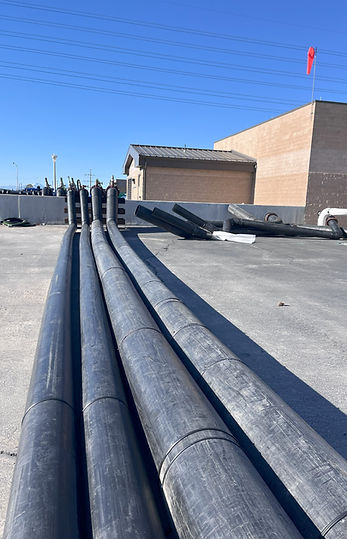

The big black plastic bypass pipes and pumps have all been moved upstream, northeast into the farmland. This stage of the project in the residential subdivision is now in a new phase - wrap up and restoration. The small-scale batch plant will be relocated soon, as well a lot of the material that has been a constant as trenches were excavated and large pipe sections placed into the ground. The contractor will now be working on rough grading to re-establish the ground level and slopes. Curb, gutter and sidewalk will be formed up and new concrete will be poured to replace or repair what was removed or damaged. Temporary asphalt will be paved in street sections where the large 60-inch pipe cut through roadways. This effort will continue for the next month as weather and schedules permit. Further north and east the trenching and pipe laying will continue.
December 5, 2024

Early May 2024

Update - November 25, 2024 - Continued Progress

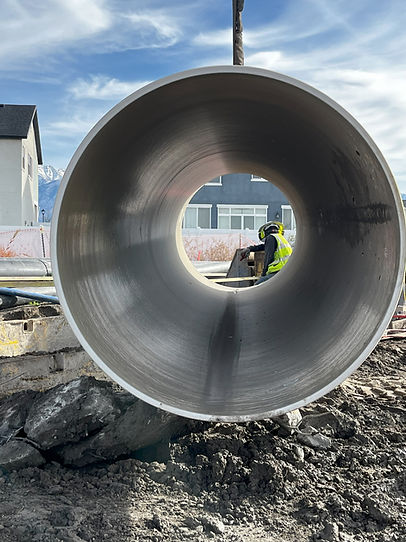

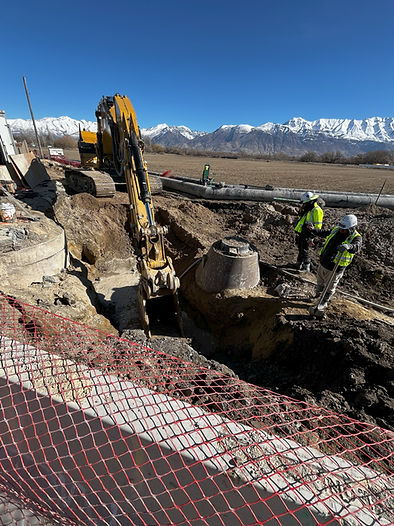

Three excavators were necessary to set this Hobas T. Getting a T in the right place, elevation and slope can be tricky. These big pieces of equipment can move a lot of dirt in a hurry with a big scoop and heavy hydraulics. The precision that is required to finesse the large 60-inch pipe into place is a bit deceiving. While often compared to a joystick on a high-tech video game, these equipment operators have honed their craft and know how to manipulate multi-ton pieces of equipment for a precise pipe fit.

The excavator operator making incremental adjustment to make sure the Hobas T is consistent with the project design specifications.

The heavy digging, back filling and pipe setting is now passed the Woodside subdivision. Progress continues as the pipe is laid in the farmland to the west. This area will continue to be an active work zone, but now more in a support role. Some of the material is still being prepped and stored in this area, but you will soon start to see this area reduce in activity, equipment and material. In a recent construction meeting the contractor reported plans for restoration and finished grade for areas where the pipe was buried in the pipe alignment easement. The project greatly appreciates your continued patience as this portion of the project wraps up.
Update - November 13, 2024
This week 100 linear feet of pipe was installed and about the same amount back filled and covered. This brings the total to about 1700 linear feet of pipe laid and covered.
​
The contractor is now beyond 420 West Street with trenching, laying, and backfill. The road should be re-opened this week. The project will continue to move northwest into the farmland and away from the subdivision. There will still be a significant amount of grading and road restoration work to take place, which includes curb, gutter, and sidewalk and a smooth road surface. Some of that work will take place next spring. You will also start to see the long, large black pipe being removed and placed farther to the north and west, as the bypass pumps in this location are discontinued.
​

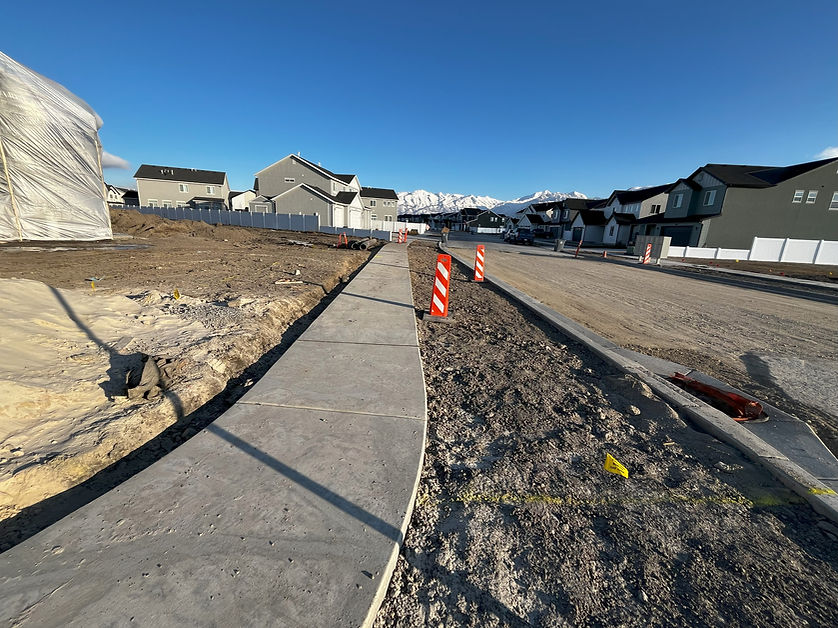

420 West Street being prepped to re-open the end of this week.

A few weeks ago, we indicated that an important element of the construction project is the quality control and testing of the pipe. Here are two images of tools that are used to perform quality control and testing. The first is a large, deflated rubber bladder. Two of these are placed inside the pipe and then inflated to form a tight seal with a joint in between. Air is pumped into the pipe section, placed under pressure and the seal is held for a brief period of time. This description of the process is simplified, but if the pressure holds, the seal is good and passes inspection. If the pressure reduces, the seal is bad and then must be repaired.
The second picture is that of a small robot camera used to travel the length of the pipe to provide a visual inspection. The camera head is able to rotate 360 degrees and view all aspects of the inside of the pipe. The robot camera also records the journey down the pipe and serves as a visual record of the quality and cleanliness of the pipe prior to the contractor turning it over to the owner, or in this case the Timpanogos Special Service District (TSSD).

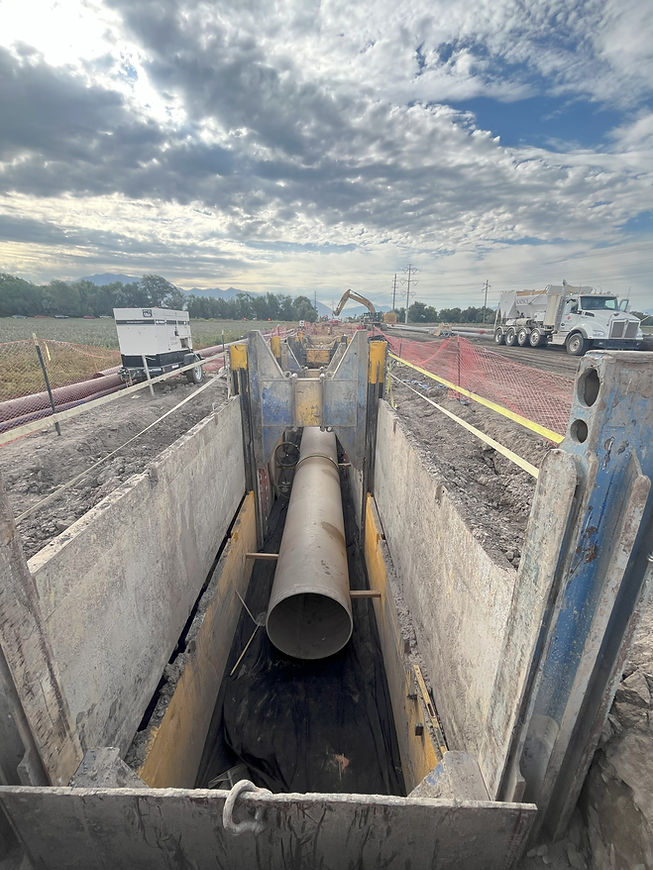

Pipe being set into place from the ground into the trench.

Update - November 8, 2024
This week 90 linear feet of pipe was installed and about the same amount back filled and covered. This brings the total to about 1600 linear feet of pipe laid and covered. The contractor is now beyond 420 West Street which should be re-opened next week. The project will continue to move northwest into the farmland and away from the subdivision. There will still be a significant amount of grading and road restoration work to take place, which includes curb, gutter and sidewalk and a smooth road surface. Some of that work will take place next spring.

One tool the contractor has used to make the process go faster is the use of slide rail retaining walls. This allows the excavation process to move much faster because each framework piece attaches to the next and can be removed when ready with minimal disturbance to the backfilled trench. This slide rail keeps the dirt sidewalls from caving in and provides a safer working environment for the contractor.

Update - November 1, 2024 - The light at the end of the tunnel!!
This week 180 linear feet of pipe was installed and about the same amount back filled and covered. Here are a few images and explanation of the pipe laying process. In these four images we show the process of pouring a manhole into place. First a rebar cage is formed and placed around a Hobas T. Then concrete is poured around the T to keep it secured in place. The long yellow straps are connected to a beam inside the pipe to keep it elevated enough to allow concrete to flow beneath the pipe. The last two pictures are of the riser, which is placed over the opening in the pipe, allows TSSD employees to access the pipe, if needed, from the ground surface level, hence the built-in ladder.

Along with placing the pipe, an equally important part of this project, is the removal of the old pipe. The contractor has to first remove the old pipe as a part of the process of trenching for the new pipe. The new pipe is larger and deeper, thus providing more sewer flow capacity to the existing TSSD sewer plant. The old pipe is crushed and hauled away.

This is a really good sign, the backfill and compaction of the newly laid pipe. It is significant in that it indicates the major heavy work is done!! There is a light at the end of the tunnel.

Where has this project been and where it is going? Moving from the southeast area, south of the existing home, the project continues to move northwest, away from the houses and into the farmland. To be sure, the inconveniences to the residential neighborhood have been real, even as all necessary mitigation was attempted. The disruptions to the new areas, such as the farmlands, are no less challenging. The contractor will continue to work hard to minimize impacts such as use/access of land, noise, dust and vibrations. The project team greatly appreciates the patience and cooperation of everyone involved, especially those closest to the work zones. Thank you!!

Update - October 24, 2024 - It's all about the seal!!
This week 100 linear feet of pipe was installed and about the same amount back filled and covered. Here are a few images and explanation of the pipe laying process.

Inspecting the pipe before it is lifted into the trench.

Lifting the pipe down into the trench.

Removing any irregularities that would prevent a tight seal.

Preparing to make the next connection.

Ground water infiltration is one of the challenges with laying large pipe where the water table is high. Using compressed air, gages and large rubber bladders that act as a temporary plugs, the pipe is placed under pressure to make sure the pipe joints are sealed and set properly. If the pipe joints are not tight, ground water can enter the pipe and require the sewer treatment plant to process more material than needed. With miles of pipe, even a small number of leaks can add up to thousands of gallons of extra and unwanted water in the treatment plant to be processed. This can add additional and unnecessary costs.
Update - October 17, 2024
The contractor is making great progress. In the last week there have been 270 lineal feet of pipe laid. Right now, the contactor is averaging between 40 and 50 feet a day. It is anticipated that progress will continue, though the wet and colder weather season is now here which can slow progress. The slide rail system is working well, and there is only one more north/south street in the neighborhood to cross - 420 West.
​
Last week we mentioned how complicated this project is - ground water, working in confined spaces, road crossings, existing utilities, etc. That is just to get the pipe in the ground at the right depth and the correct slope. In addition to all that, the contractor and the engineers need to assure that the pipe is still round and that all the pipe joint connections are sealed properly. There is a test for everything. Large balloons or bladders are used to seal sections of the pipe, pressurized air is pumped into the pipe section and then tested for leaks. The Hobas pipe is strong, but there is also a test with a mandrel (a circular calibration device) to check that the pipe remains round within a certain degree of tolerance. If the pipe becomes compressed, oval or out of round it can lead to weakness in the pipe or impact the flow line of this gravity fed system. And although this is a very large sewer pipe, it also has to be cleaned of any construction debris, dirt, water bottles, lunch sacks, articles of clothing, etc. so that the flow line is assured.
​
Next week, there will be an isolated temporary culinary water disruption on Monday and Tuesday, October 21 & 22 from the hours of 8 a.m. to 5 p.m. while the contractor works on the water line. Those homes that will be impacted have been notified.
​
​
Update - October 10, 2024 - It's complicated!!

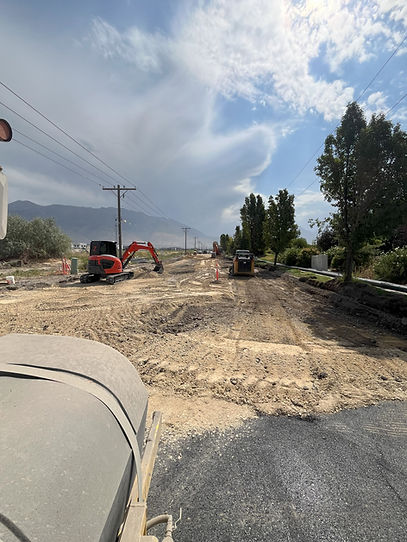

The contractor is currently crossing 380 West at about 900 South with the 60-inch Hobas pipe. In this roadway there are numerous utilities that must be accommodated or worked around. Some are capped and then fed from another direction, others are temporarily shut off until the pipe and the work zone are passed the involved utilities. One of the complications working through existing utility trenches is that they tend to collect water and channel it to the active work zone, making conditions even more complicated.
In the last six days about 110 feet of new pipe has been laid, and 120 feet of previously laid pipe has been backfilled and partially covered. The contractor continues to make good forward progress and is hopeful to be out of the residential area by the first part of November.
In the image below you can see water pouring into the pipe trench from the right side, just to the right and a little below the hanging hose. At times there are more than 500 gallons of water per minute flowing into the work area, of which, that water must be pumped out and directed out of the work area. Without the heavy steal sidewall shoring, these trenches would collapse and making trench work nearly impossible and dangerous for construction workers.

In this image you can see heavy concrete blocks sitting on top of the pipe. These blocks are temporarily placed on top of the pipe so that when the CLSM or flowable fill are placed around the pipe, the pipe stays in place and does not float upward and get out of alignment. Once there is enough weight on the pipe, the blocks are removed.

A new manhole has been placed and ready to receive the next section of pipe.

Update - October 3, 2024
It has been a productive seven days since the last update. The contractor was able to dig and lay 240 feet of trench and pipe. One new Hobas T and one box utility access were installed. An additional 240 feet of trench was backfilled over the recently installed pipe. If progress continues at this rate, this section of pipe will be completed, and the contractor will be out of the residential area by the end of the month. Here are some photos from the job site and specific details of certain aspects of the project.
Down in the pipe trench the workers are placing bedding gravel for the pipe to rest on before another section of pipe is added and backfilled around the pipe. The workers use a laser level to make sure that each section of pipe is placed at the right depth. This is a gravity flow pipe, meaning the pipe contents is not pumped, but relies on gravity to flow from the source point to the Timpanogos Special Service District treatment plant - further southeast where the pipe is currently being installed. The laser level also helps assure the angle or the right grade is achieved so that the pipe contents will flow properly and unobstructed.

Here the workers are inspecting the rubber gasket that provides a tight seal to reduce the possibility of any leakage.

Here is a utility access point before the stand pipe cones or rings are placed over the opening so the pipe can be accessed later if needed by maintenance workers. You can also see the CLSM ( controlled low-strength material- like a super runny concrete mix) which is used to backfill immediately around the pipe zone. CLSM is used because it is self-leveling, fills all the voids, and provides a solid base for more compactible material to be placed on top of it.

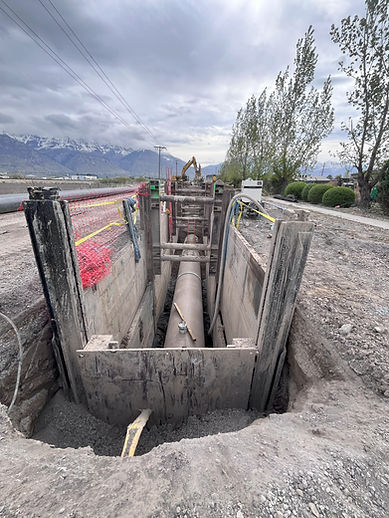

Here is a picture of a Hobas T elevated above the pipe to provide safe access in the future if needed for maintenance and inspection purposes.

Update - September 26, 2024
We are excited to report a nice project status update - since starting in the middle of June the contractor has placed 759 lineal feet of Hobas pipe, backfilled approximately 500 lineal feet and 120 lineal feet of Hobas pipe since last week. That is great progress. As of this date, weather and supplies permitting, it is anticipated the contractor will be out of the residential area the first part of November with the trench excavation, piping placement and backfilling. There will still be some residual site cleanup and grading, but it is hopeful the heavy construction and loud noises will be done.
We are providing a few more photos of the work zone.
Back filling around the Hobas T - pipe access

Compacting around pipe zone

Preparing pipe bedding and ready to lay the next section

Update - September 19, 2024
The contractor continues to make good progress on the excavation, placement of pipe and backfilling the deep trench. More detail on the Hobas T Pipe is provided from pictures down in the pipe trench zone. The rebar cage was set into place last week and concrete will be poured on Friday.
​
Another detail of interest is the flowable fill or CLSM used to backfill around the pipe zone. Controlled low-strength material (also known as CLSM) is poured onto the pipe. As the name suggests, it is low strength or concrete of a lesser strength, that adds weight and provides an encasing function around and on top of the pipe before dirt is placed back into the pipe trench to bring it back up to the surrounding grade.
​
​It is anticipated that the new pipe placement through this section of the residential subdivision will be complete toward the end of November.

Additional work updates
There have been some changes to which roads are now open and which are closed. 250 West is open. There are still large steel plates and a little asphalt bump. This is not the permanent reconstruction of 250 West.
The temporary main line sewer bypass pipes are still functioning and are still minimally buried to allow traffic to pass over these pipes. Once the new large 60" pipe is in place and functioning, the temporary bypass pumps will be removed, and the road will be reconstructed without bumps or large steel plates. This will likely happen early next Spring. ​

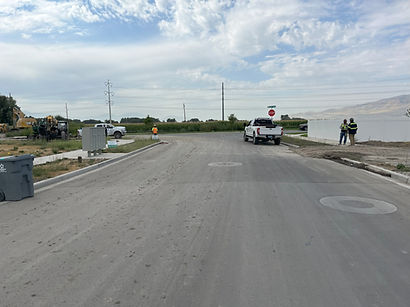

In addition, the intersection of 910 South, 370 West and 380 West is now closed and will remain closed until the new 60" sewer line passes through this section of roadway.

Update - September 11, 2024
This week the contractor continues to excavate, lay pipe and backfill the open trench. Of particular interest this week is the placement of a Hobas pipe T (see picture below), which provides access and maintenance opportunity along a straight run of pipe, whereas a concrete man-hole is placed in the pipeline at angle points or where another pipe is entering from a perpendicular direction.

Ongoing Work
This week the contractor is also working on the pressurized irrigation system in 250 West. In order to accomplish this work, there will be a temporary shut off of the pressurized irrigation system for the entire day on Thursday, September 12th. A 24 hour advance notice was given to those homes being impacted on Wednesday, September 11th. This is for pressurized irrigation only and will not impact the drinking water (culinary system).
​
In addition, the contractor is working to restore the 250 West road section for vehicle access. The goal is to have this completed by the end of next week - September 20th.
Update - September 5, 2024
This past week the contractor made excellent progress by laying 135 feet of new 60-inch sewer pipe. Their system of using slide rail trench retention, processing fugitive ground water, excavation and backfilling on top of the pipe is really starting to come together. This equates to laving about forty feet of pipe per day.

Ongoing Work
Next week the contractor will be working on the pressurized irrigation system in 250 West. In order to accomplish this work, there will be a temporary shut off of the pressurized irrigation system for the entire day on Thursday, September 12th. A 24 hour advance notice will be given to those homes being impacted on Wednesday, September 11th. This is for pressurized irrigation only and will not impact the drinking water (culinary system).
Update - August 29, 2024

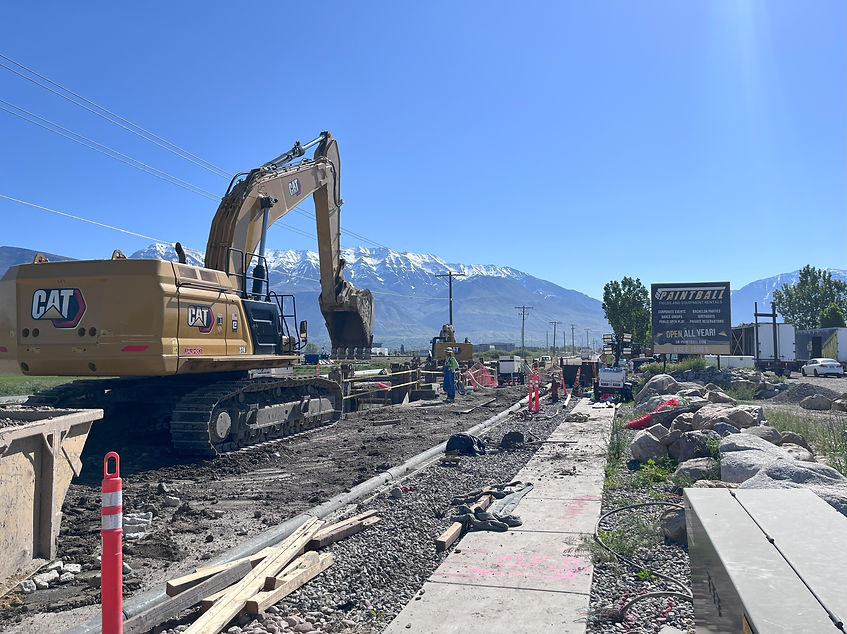

The contractor has changed trench retention methods from traditional fixed trench boxes to a slide rail system, which should allow the contractor to make more steady progress. The new system allows for new sections of trench retention panels to be added to the vertical posts, slid into place, and keep extending out towards the desired working direction.
​
The utility work on 250 West is mostly done. The contractor reconnected a looped water line and Dominion Energy is re-establishing some of its gas lines. This is all in preparation to eventually replace the curb, gutter, sidewalk and asphalt in the 250 West road alignment. Thank you for your patience and understanding to those few homes that had a disruption of water service for several hours during the day this last Tuesday.
​
With Monday being Labor Day the contractor will not be working on the job site. School children and many others will also be enjoying the holiday, we ask parents to keep curious children away from the active work zone. Your continued safety and caution is greatly appreciated.

Update - August 23, 2024 A cautionary reminder
With children now in school and with them walking to and from school bus stops - pedestrian safety and keeping an eye out for large construction vehicles, even away from the construction zone, is very important. While most of the heavy equipment will be near, in and around the active construction zone, there will still be construction traffic and some equipment on the local residential streets. Sundt Construction is working with their construction crews and sub-contractors to be on the watch for pedestrians of all ages, kids on scooter and other motorized vehicles. For neighbors and local residents your vigilance and caution are also greatly appreciated.
This week the contractor continues to focus on back filling the trenches where the new sewer line pipe has been placed. The two large black pipes function as the temporary sewer bypass system as the old pipe is removed and as the new pipe is put into place. The contractor has also been working on stabilizing the double pipes as these are located in close proximity to the new pipe trench.
Crews are also working on restoring the road and utility connections in 250 West. Early next week the goal will be to make continued progress with re-establishing the road and utilities. This will require a temporary water shut off on Tuesday, August 27th for a few hours in the middle of the day. Those who will be directly impacted will receive a 24-hour notice in advance of the shut-off. The notice will contain specific details of the shut-off and suggested preparations during that time.
​
Towards the end of next week, the contractor will continue with the deep trenching work to lay more pipe.
​
.jpg)
Update - August 15, 2024
This week the contractor has focused on back filling the trenches where the new sewer line pipe has been placed. The two large black pipes function as the temporary sewer bypass system as the old pipe is removed and as the new pipe is put into place. The contractor has also been working on stabilizing the double pipes as these are located in close proximity to the new pipe trench.
Crews are also working on restoring the road and utility connections in 250 West. Early next week the goal will be to make continued progress with re-establishing the road and utilities. This will require a temporary water shut off on Tuesday, August 20th for a few hours in the middle of the day. Those who will be directly impacted will receive a 24-hour notice in advance of the shut-off. The notice will contain specific details of the shut-off and suggested preparations during that time.
​
Towards the end of next week the contractor will continue with the deep trenching work to lay more pipe.

Update - August 8, 2024
Sundt Construction continues to make good progress on the trench and pipe work.
The major update for this week and next is the contractor will bring on a second crew to work on the west side of the project and move in a northwest direction. They will also start working until 7 pm, Monday through Saturday in order to keep on schedule to finish this area by the first part of September.
​
With the extra crews, longer workdays and now school starting soon, the construction zone and surrounding side streets will be more congested. Please be cautious and slow down on local streets near the construction zone, be mindful of traffic control devices, detour and warning signs. Your continued patience and cooperation are greatly appreciated and keeps everyone safe.
Update - July 25, 2024
Sundt Construction has made good forward progress in the last few days. From the first picture on the left, ground water is visible, which is why there are additional pumps continuously running to reduce as much ground water as possible from the trench and pipe zone. The ground water makes deep trench work even more challenging. From the picture on the right, the contractor has placed a line on the ground, marking out anticipated trenching for the next few days. ​
​
As proximate residents, your continued patience from construction related noise and dust is greatly appreciated, in addition to keeping a safe distance from the work zones. Again, the goal is to be finished with this area by the first of September of this year.

Update - July 19, 2024
A challenging part of the project in this area has finally been achieved, the placement of a very large manhole. This is a critical component, as the lay of the land is very flat. This section of sewer pipe is gravity flow, literally following a very flat slope. The placement of the manhole is significant as it helps determine the slope and depth of future pipe sections. Now that this critical piece is in place, you should start to see more trenching and additional pipe sections being installed, backfilled and compacted.
Although next week is July 24th and a local celebration of Pioneer Day, the contractor will be working, so the construction zone will be active. Please continue to avoid the active construction zone and other areas that have been blocked off by the orange caution fence.
Looking a bit further in the future, the contractor has a projected goal to be completed through the Woodside Homes development by the first of September. If you do have questions or comments related to this project, please reach out via the hotline or email address.

Update - July 12, 2024
The contractor has started laying the 54 inch pipe in the trenches. Please be mindful and stay out of the construction area. These large open trenches will continue to be barricaded with the orange plastic grid fencing. As old pipe is removed and the new pipe installed, the trenches will be backfilled and compacted. The active construction zone will include excavators, dump trucks and water trucks, along with other construction equipment. It is critical to stay clear of these areas whether there is active construction or not.
In order to stay on schedule and move away from the residential areas as quickly as possible, the construction crews will also be working on Saturdays through September. It is anticipated that this work will be during regular construction hours.
Update - June 28, 2024
This week the deep trenching has commenced. These large open trenches will continue to be barricaded with the orange plastic grid fencing. As old pipe is removed and the new pipe installed, the trenches will be backfilled and compacted. The active construction zone will include excavators, dump trucks and water trucks, along with other construction equipment. It is critical to stay clear of these areas whether there is active construction or not.
​
With the 4th of July holiday approaching, construction crews will secure the active construction zones as much as can be. Crews will not be working Thursday, July 4th through Sunday, July 7th. Work will commence again on Monday, July 8th. In order to stay on schedule and move away from the residential areas as quickly as possible, the construction crews will also be working on Saturdays through September. It is anticipated that this work will be during regular construction hours.

UPDATE - June 13, 2024
The construction zone is increasingly getting more complicated with numerous elements of the construction now in full swing. The temporary bypass pumps are now functioning. Pumping sewage from the large mainline that goes to the Timpanogos Special Service District through the large blue box shaped pumps and then into the two large, plastic, parallel lines and then back into the mainline. These bypass lines are mostly above ground, except where they cross local roads, and in those instances, they are placed in temporary trenches through the road, covered with large steel plates.

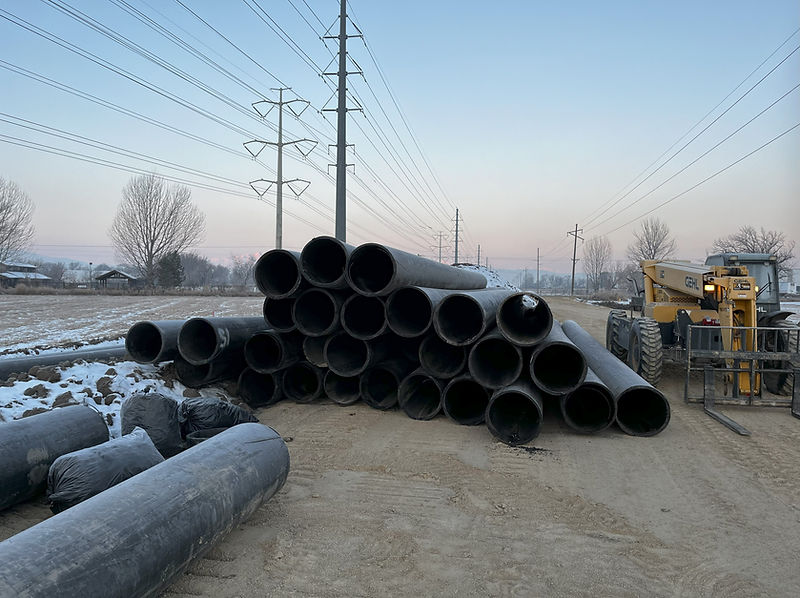

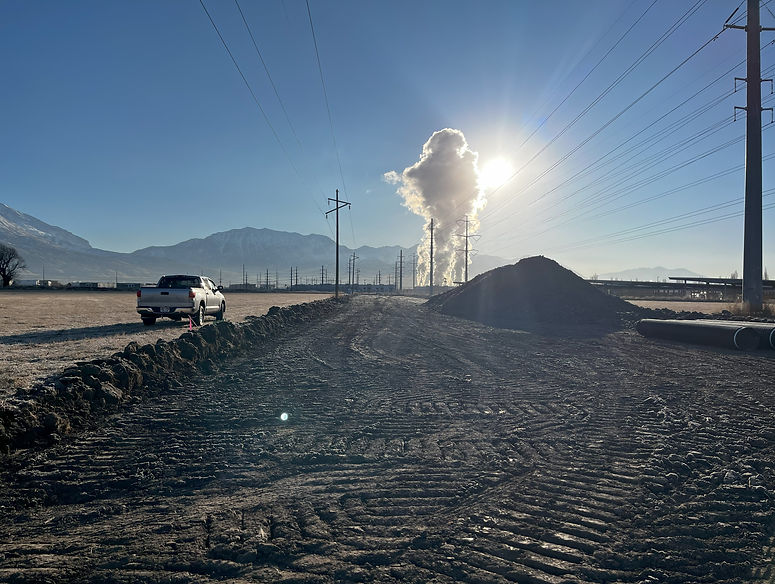

There are ground water pumps lowering the nearby water table to facilitate trench excavation. Trench digging will commence in the very near future. The large sections of permanent pipe are now being delivered on site. This permanent pipe is a corrosion resistant HOBAS (manufacturer) centrifugally cast, fiberglass-reinforced, polymer mortar pipe systems - designed to last a very long time.
​
With all this construction, it is important to keep clear of these areas, even if there is no active or visible work. The construction area is not safe for kids, walking dogs and/or motorcycles - all of which have been reported in the area. We apologize for the disruption of this work. Your continued patience and caution will help the project move forward and wrap up as quickly as possible. If you have questions or concerns, you are encouraged to reach out through the hotline or email.

UPDATE - May 30, 2024
At this time, there are open trenches across roads and sidewalks in the construction zone to enable placement of the pipe. There are barricades and signage to keep the public away from these areas. Please stay out of the active construction area.
​
This coming week the contractor will be working on the following items in the Woodside Homes Development.
​
-
Installation of a Manhole
-
Begin installation of the 54 inch mainline sewer pipe
​
Note: Schedules are subject to change due to weather and materials availability.
​
UPDATE - May 23, 2024
This coming week the contractor will be working on the following items in the Woodside Homes Development.
​
Schedule for May 28th:
-
Saw cut the road for bypass pumping
-
Excavate for bypass pumping pipe road crossing
-
Install bypass pumping
Schedule for June 7th:
-
Begin installation of the 54 inch mainline sewer pipe
​
Note: Schedules are subject to change due to weather and materials availability.
​
UPDATE - May 14, 2024

As the contractor brings heavy equipment into the work zone and starts removing vegetation and digging trenches, more orange grid fence will be installed. This is placed as a bright line of distinction to stay away from, as these areas are the "active work zone" and can be hazardous due to uneven surfaces, deep trenches and heavy equipment. With warmer weather and children being done with school, we remind parents to keep their children from getting too close to these areas or crossing the orange fence and entering the active work zone. Our goal is to have the contractor work as efficiently as possible to minimize disruption to surrounding properties, but safety in and around the work zone is also a very high priority. Your assistance will be greatly appreciated.

UPDATE- May 7, 2024
This week the contractor (Sundt Construction) has mobilized (bringing heavy construction equipment on site) and will start clearing and grubbing (removing vegetation) the project area in preparation for digging the trench for the sewer from Lehi to the American Fork TSSD facility. Much of this work will be between 570 West and 100 West - though there will be frequent construction equipment traffic on adjacent surface roads. It is anticipated that trenching will commence the week of May 15th and continue for several weeks. Part of the construction work will require de-watering (a process to lower the water table to keep the trenches from filling full of water) and temporary by-pass piping (the sewer has to keep flowing in transition from the old pipe to the new pipe) which in turn will require pumps that will run continuously (24/7) for this segment of construction. The pumps are electric and will run by way of a generator, so there will be some noise associated with the pumping operation. It is not anticipated that the pumps or generators will be overly loud or beyond normal suburban background noise levels. As the sewer pipe is installed the work will continue along the Current Work Zone corridor (see map).

Grubbing will take place in the open fields

Trenching will take place south of the subdivision homes

Temporary by-pass piping

Temporary by-pass pumps

The new permanent pipe to be installed
UPDATE - April 11, 2024
​
This coming week you will see crews working between 570 West and 100 West (see map). Work will consist of contractor mobilization, survey and utility location work.
